Diocese of Norwich Outreach Center Capital Campaign
Tune back in for periodic updates!
Why a new Outreach Center?
Since the earthquake of 2010 destroyed our facilities, we have been operating from temporary facilities in 2 separate locations. We are now in a position to rebuild in a single location. This investment will allow us to:
- Consolidate our Education, Medical and Nutrition, Parish Twinning, Hospitality programs and administrative functions
- Reduce annual costs by $50,000, through consolidation, making more funds available to support and expand our program services
- Replace temporary clinic and nutrition structures with a well- equipped medical suite serving a neighborhood of 60,000 with compassionate and professional service
- Provide comfortable and secure accommodations, gathering and worship space for up to 14 international visitors
- Enhance support for over 200 students in our Education sponsorship program by creating a welcoming space for afterschool activities including life skills and computer literacy training
- Repurpose existing space on the property for visiting groups providing other volunteer services such as dental
- Provide employment opportunities to local individuals in building and renovation efforts
What is Outreach to Haiti? |
Facts |
|
|
Tax-Deductible Donations….
Check— pay to Outreach to Haiti 815 Boswell AVE, Norwich, CT 06360 Credit Card– www.outreachtohaiti.org or call 860-800-3601 Please see if your employer will match Installments available for large donations
Naming opportunities are available. Please call the office for more details.
Contribution levels
- Diamond $10,000+
- Platinum $5,000—$9,999
- Gold $2,500—$4,999
- Silver $1,000—$2,499
- Bronze $ 100 —$ 999
Please Help Our Efforts by Donating Today
Below is a Pictorial progression of the construction of the building. Most recent at the top, all the way down to the demolition.
Pictures below can be expanded by clicking on them. You can then move to other pictures in the same section by using the arrows on the side of the picture.

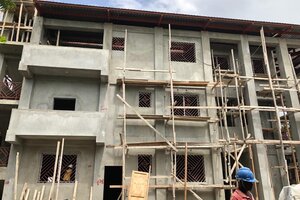

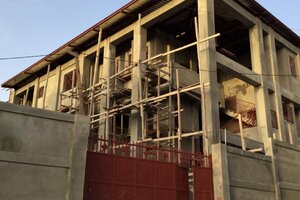

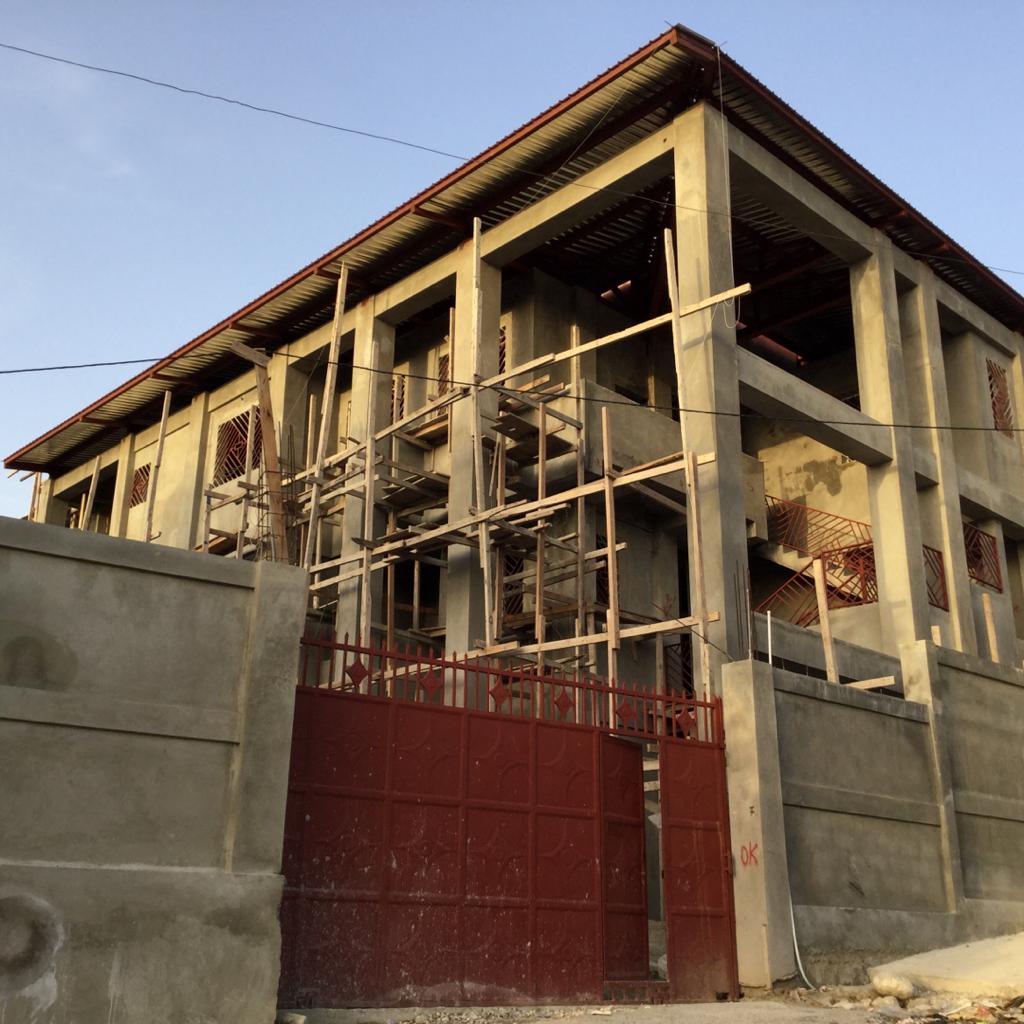

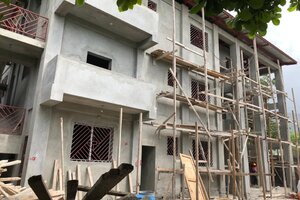

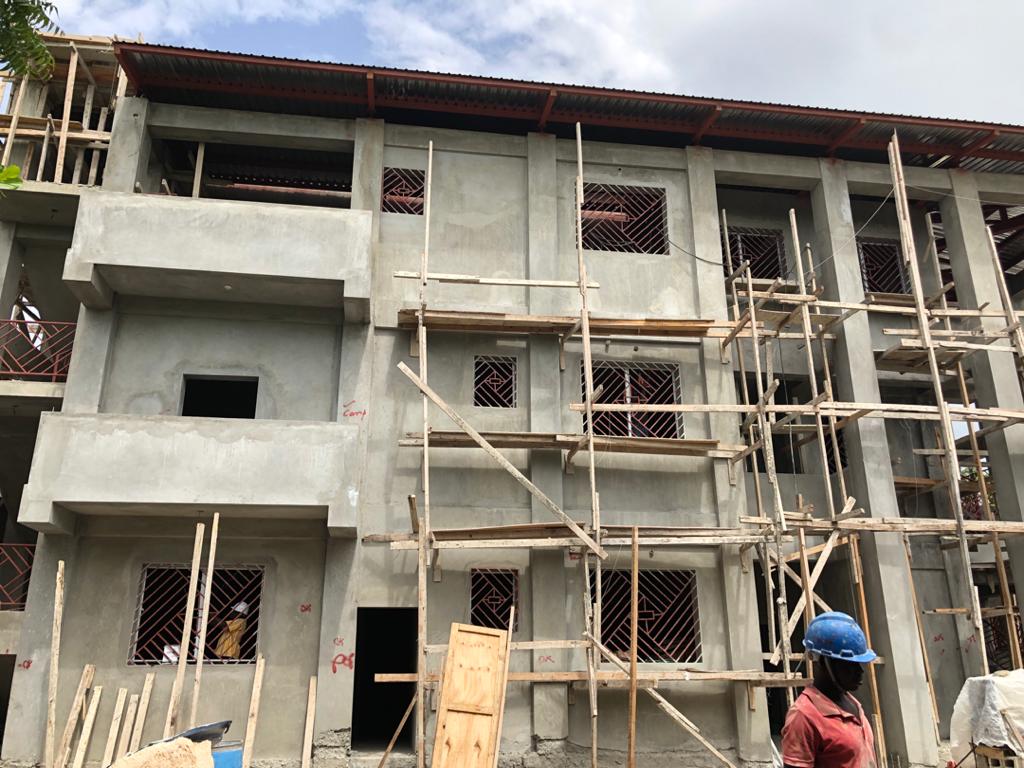

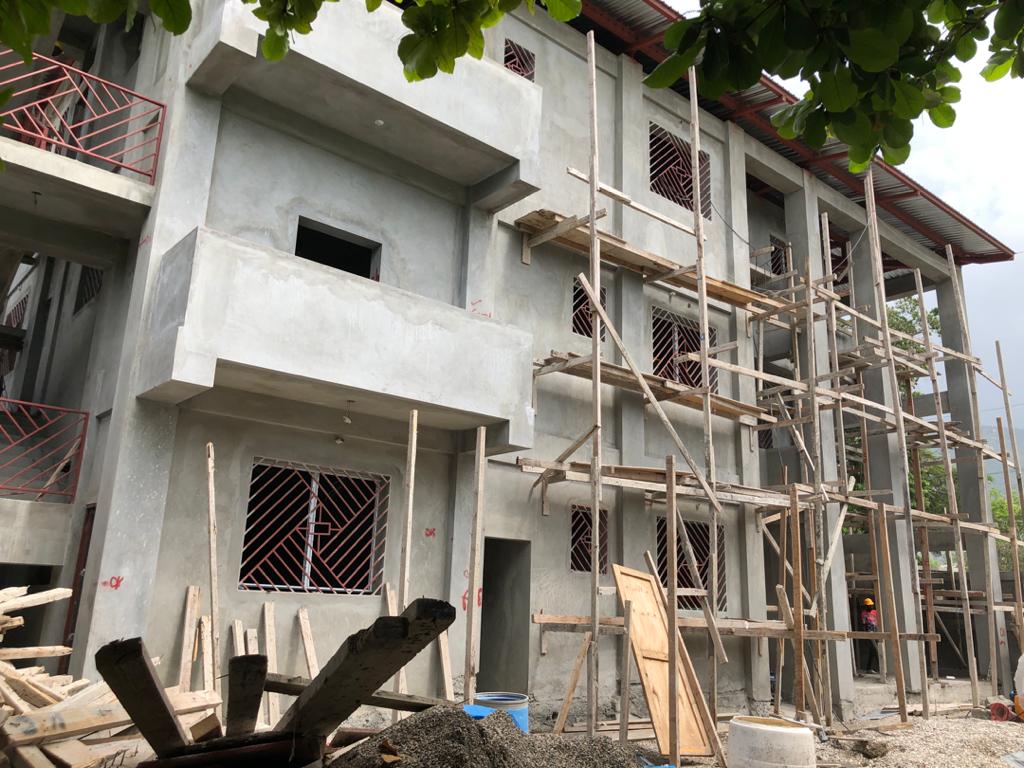

Phase 1 Nears Completion August 2021

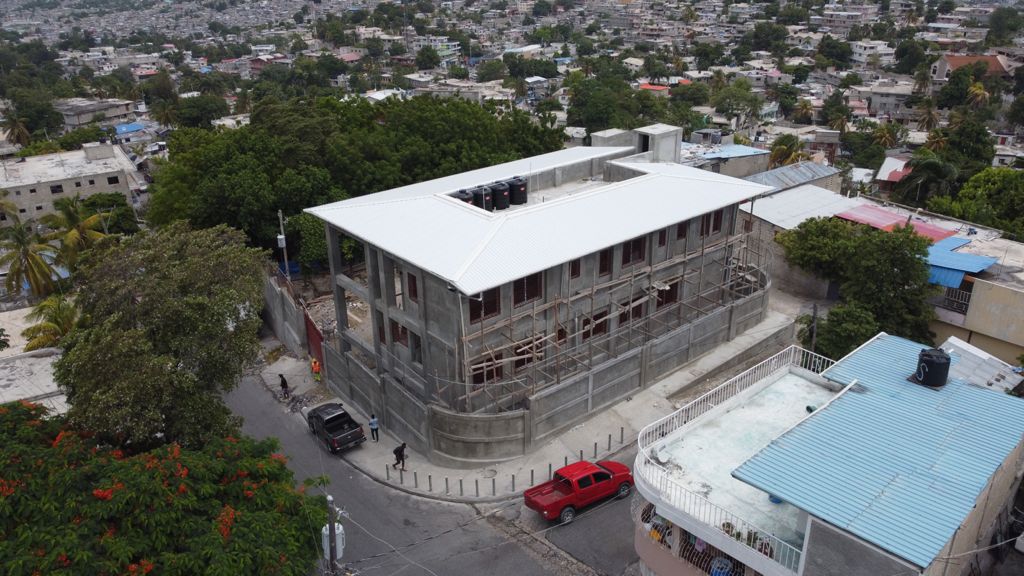

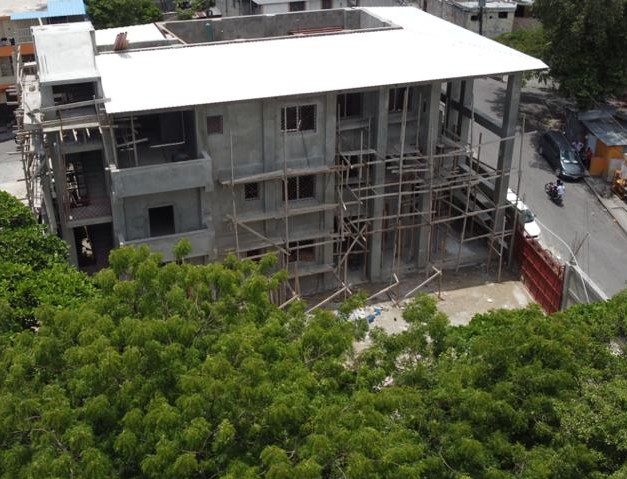

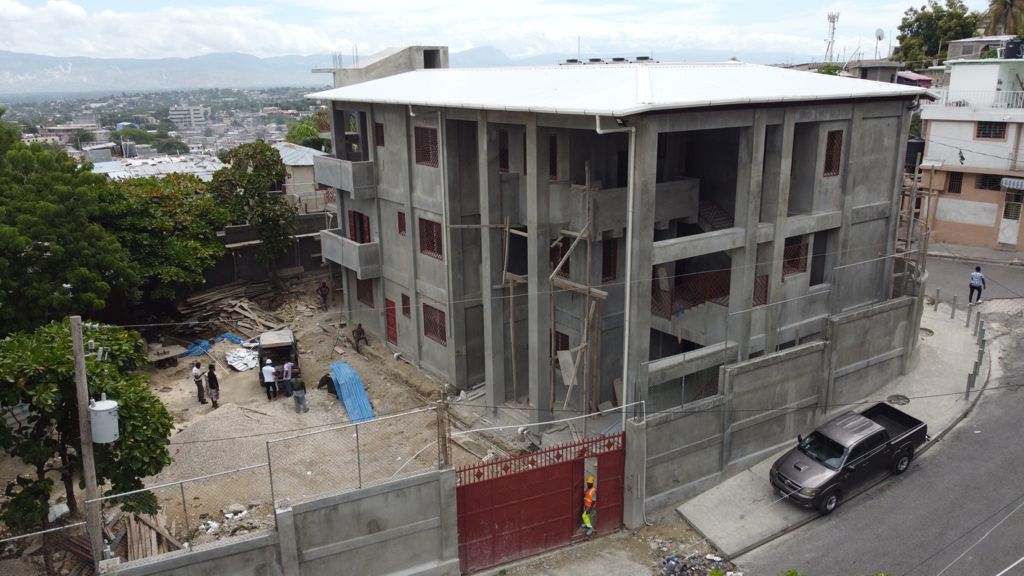

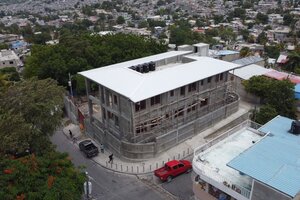

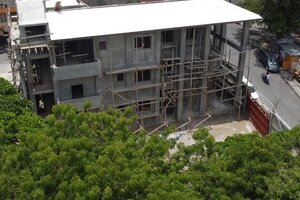

Drone shots of the Norwich Outreach Center - August, 2021

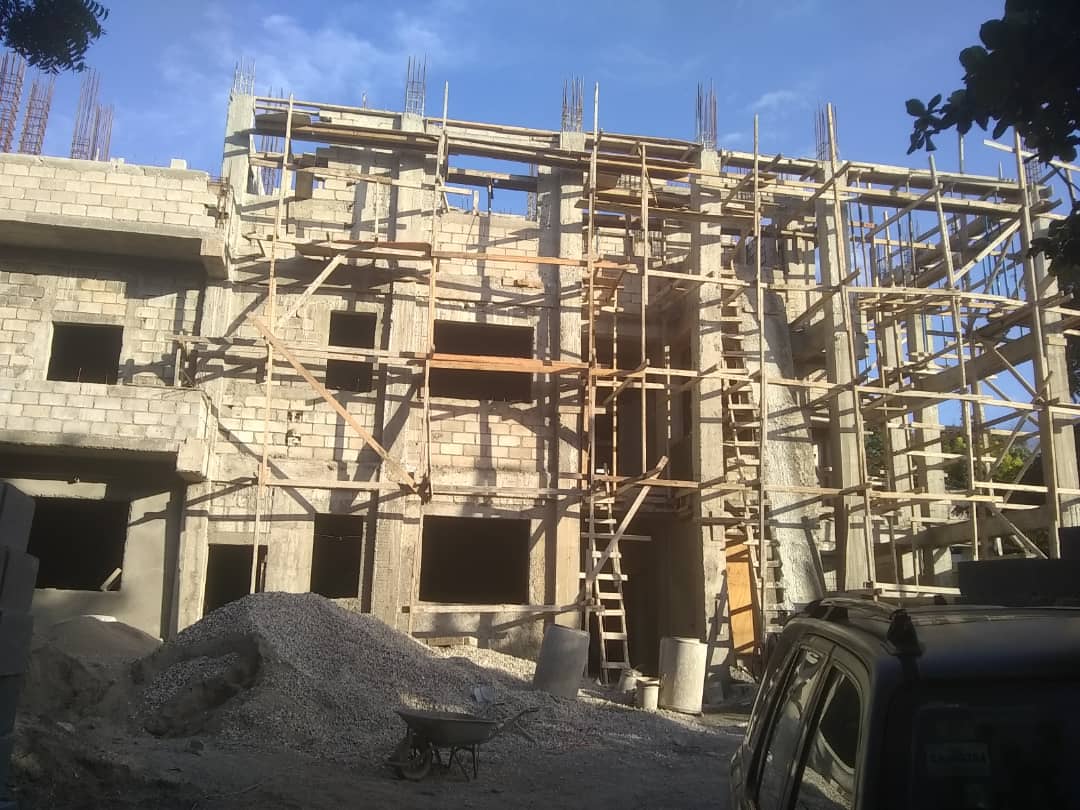

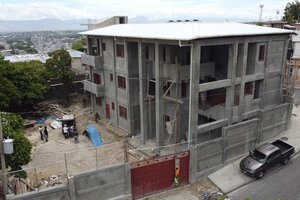

Status mid-November, 2020

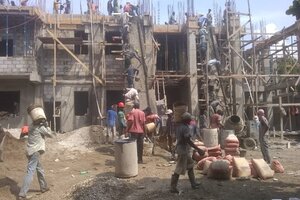

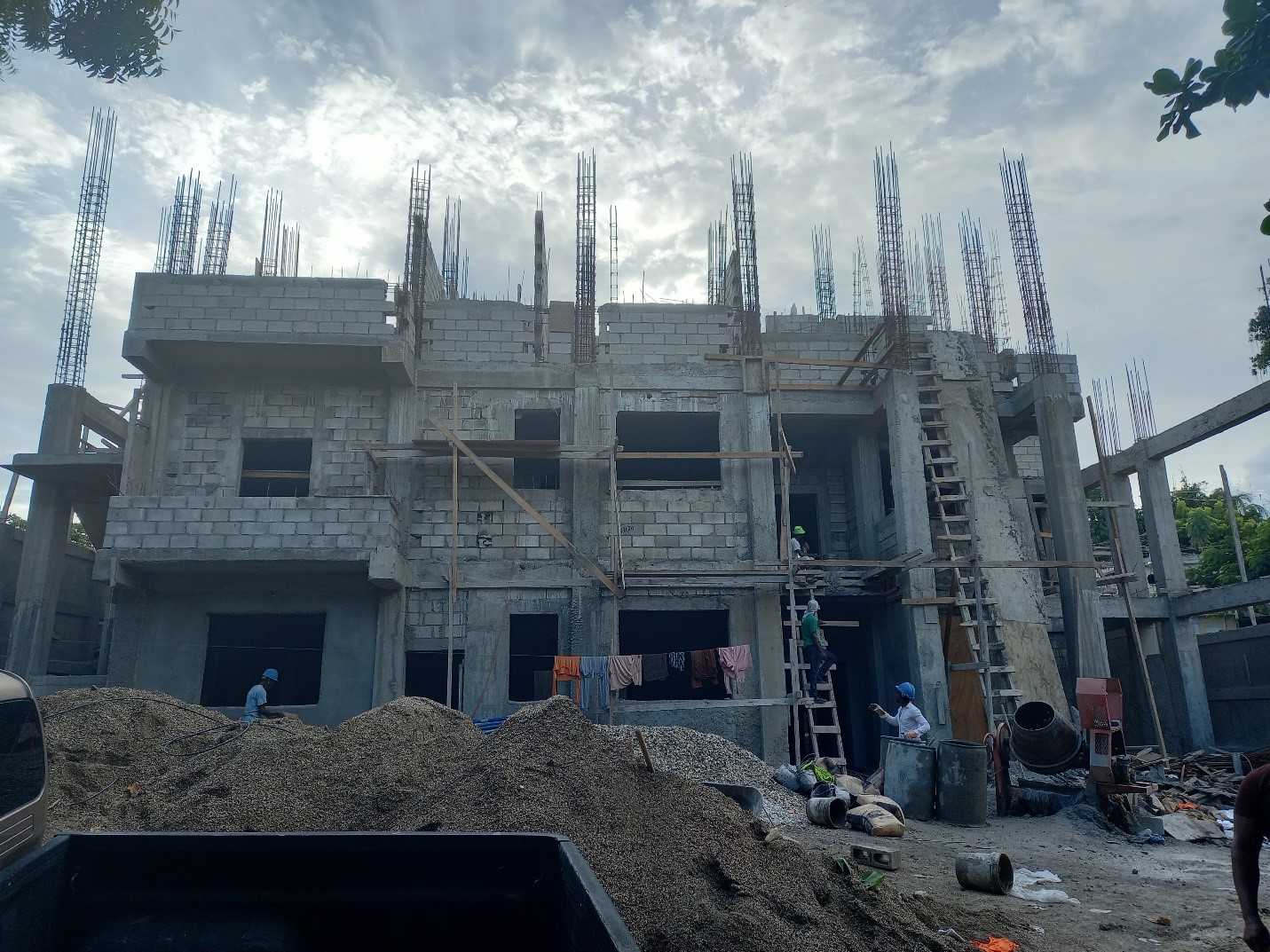

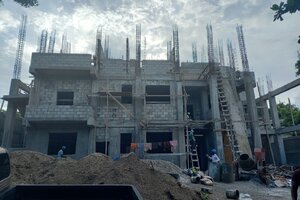

Pictures show progression from early October, when construction on the 3rd floor began to mid November where walls are about half done. The first shot shows again, how manual a process the construction is. But this is providing employment for many in the neighborhood! This is the top floor, so after this, just the roof to go, and the shell of the building will be complete
Pictures from late September, 2020
You can see from the pictures many things. The work is very manual. The progress is very swift, and the third floor base is set, and we are ready to do the walls.

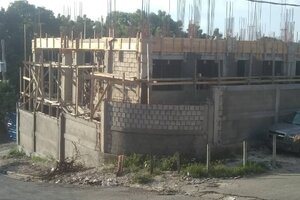

View from corner opposite the main face. Corner of Rue Moise and Rue Acacia

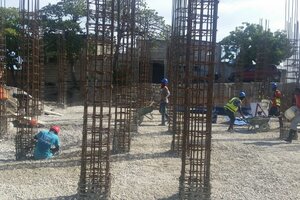

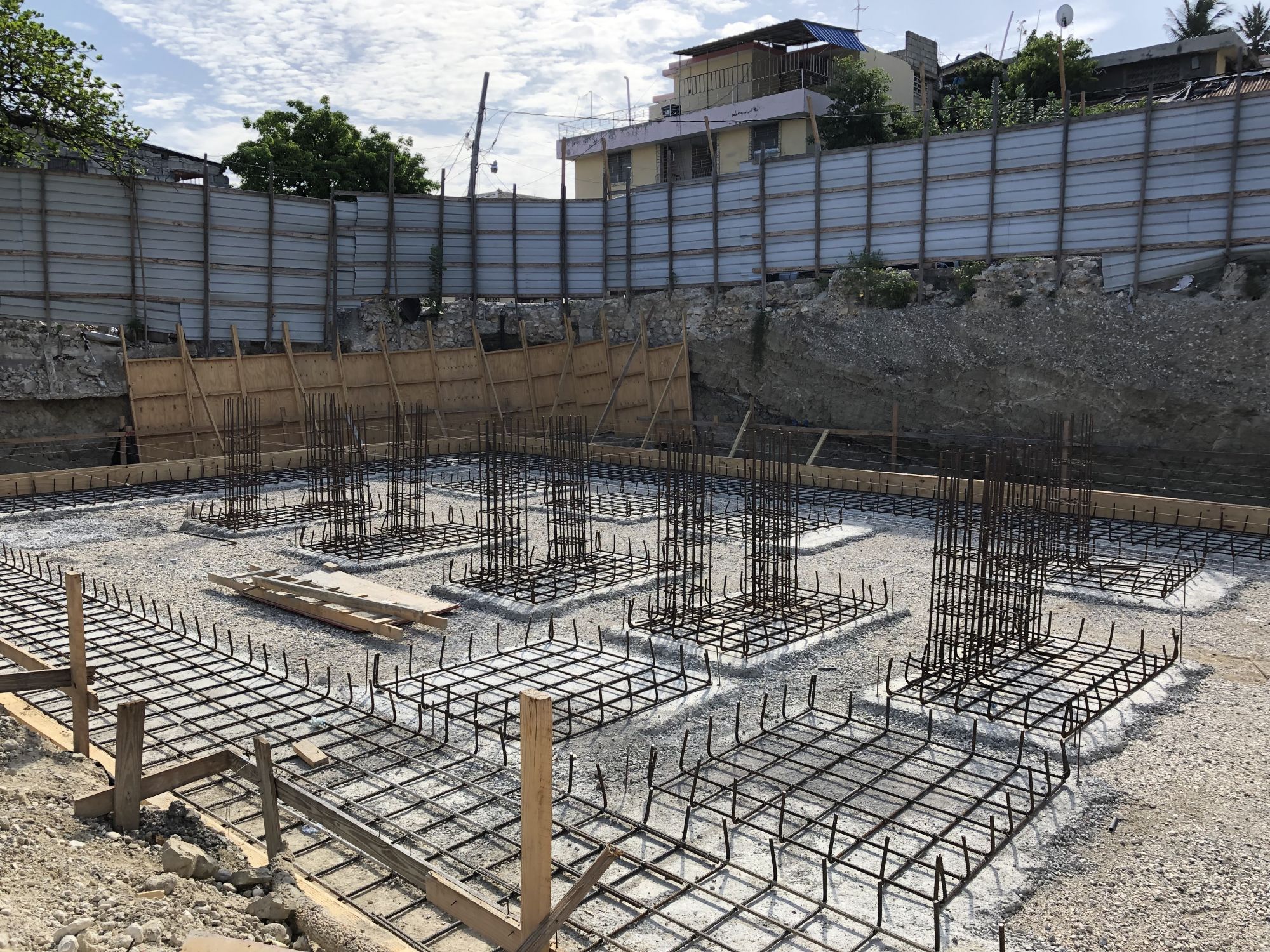

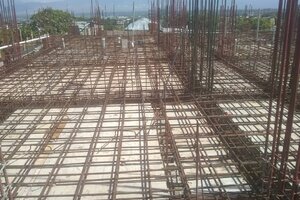

All the rebar for the third floor, and the columns is set. Ready to start "pouring" the floor.

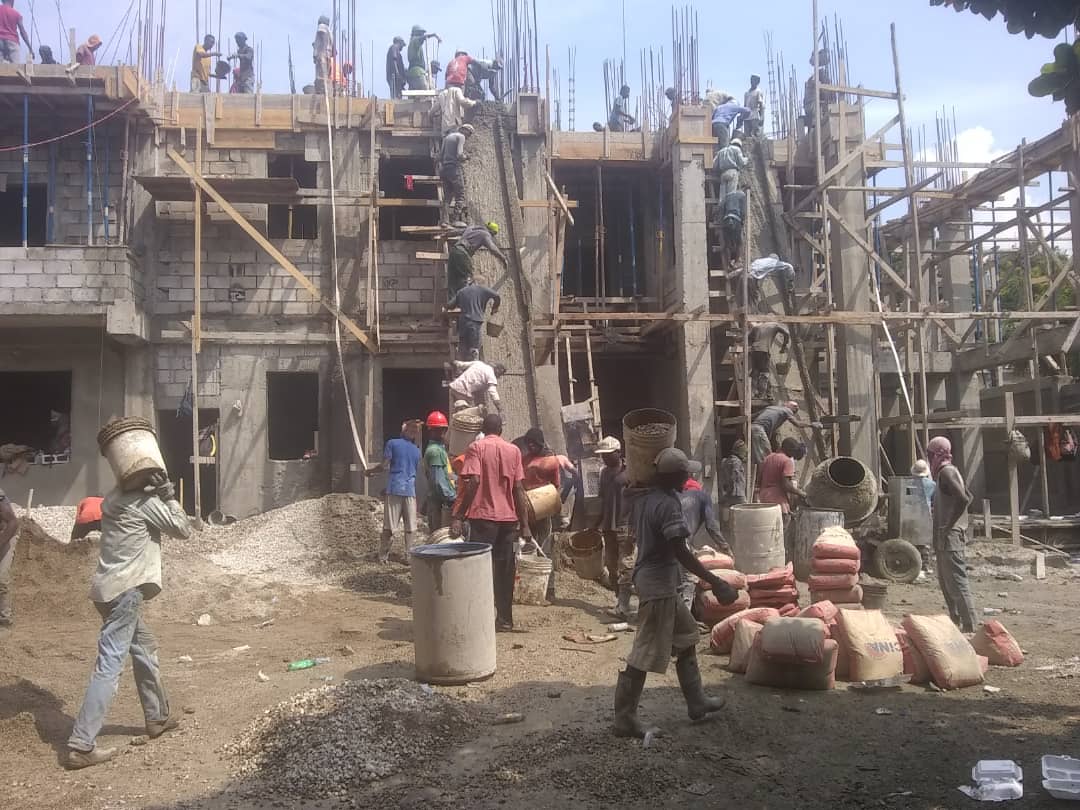

Workers mixing concrete and taking it up to the third floor - bucket-by-bucket.

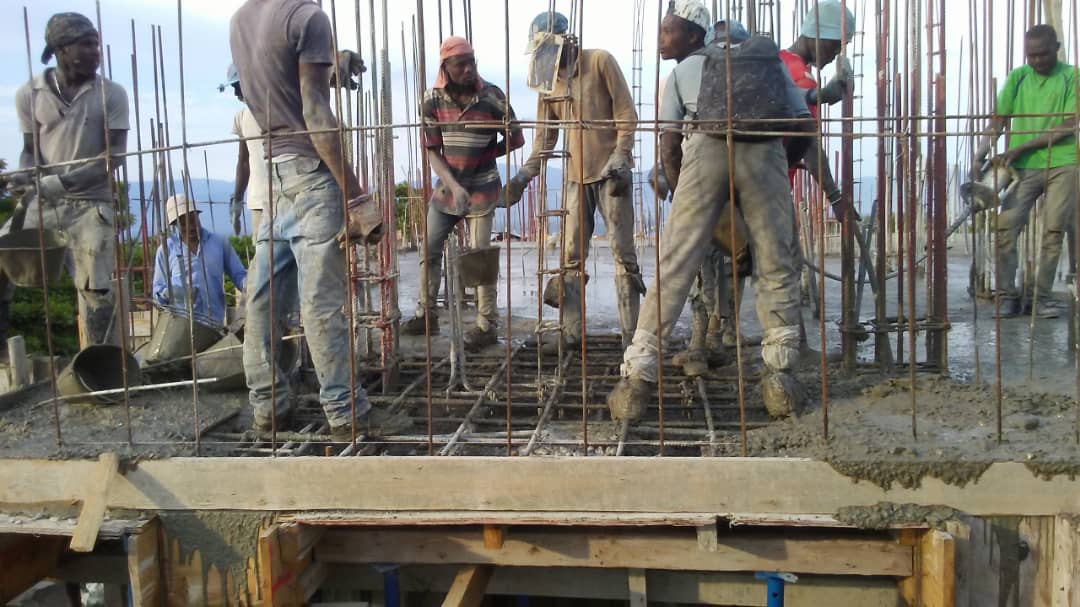

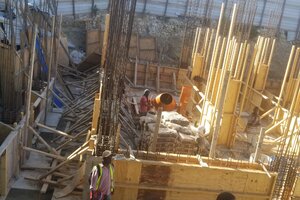

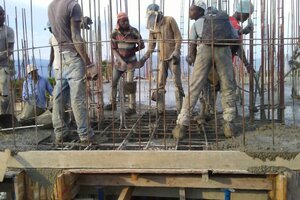

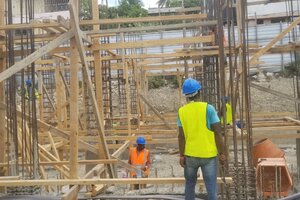

The actual "pour" on the third floor

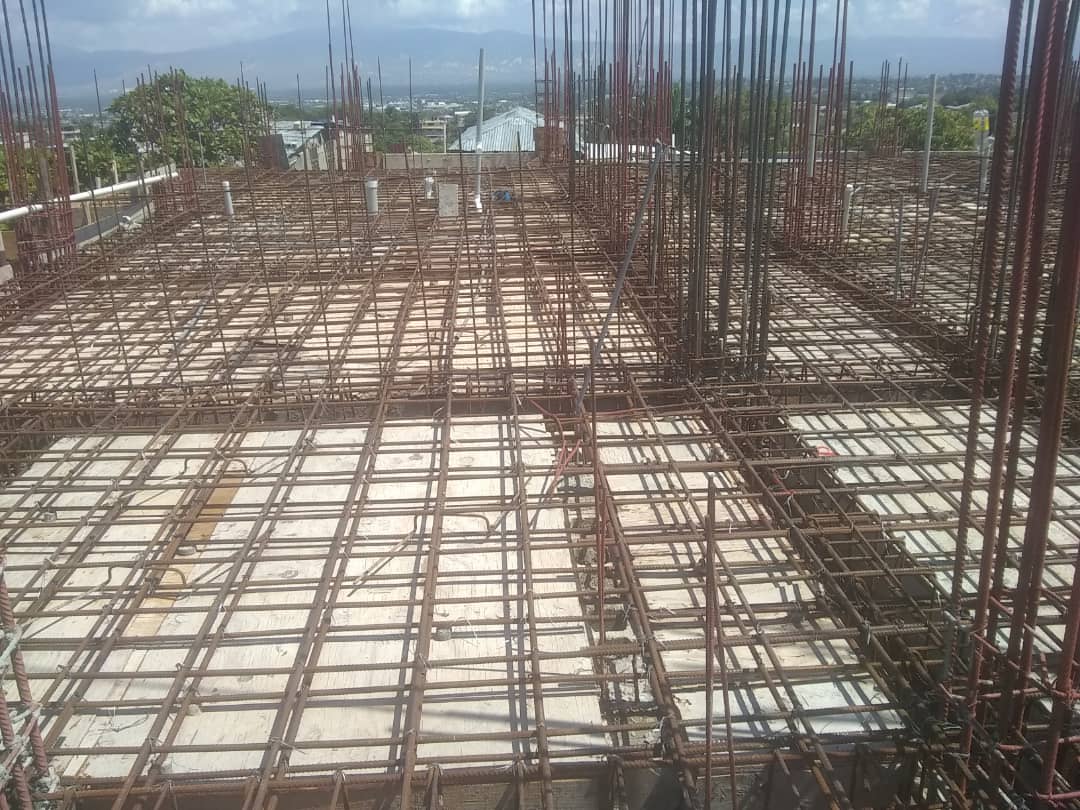

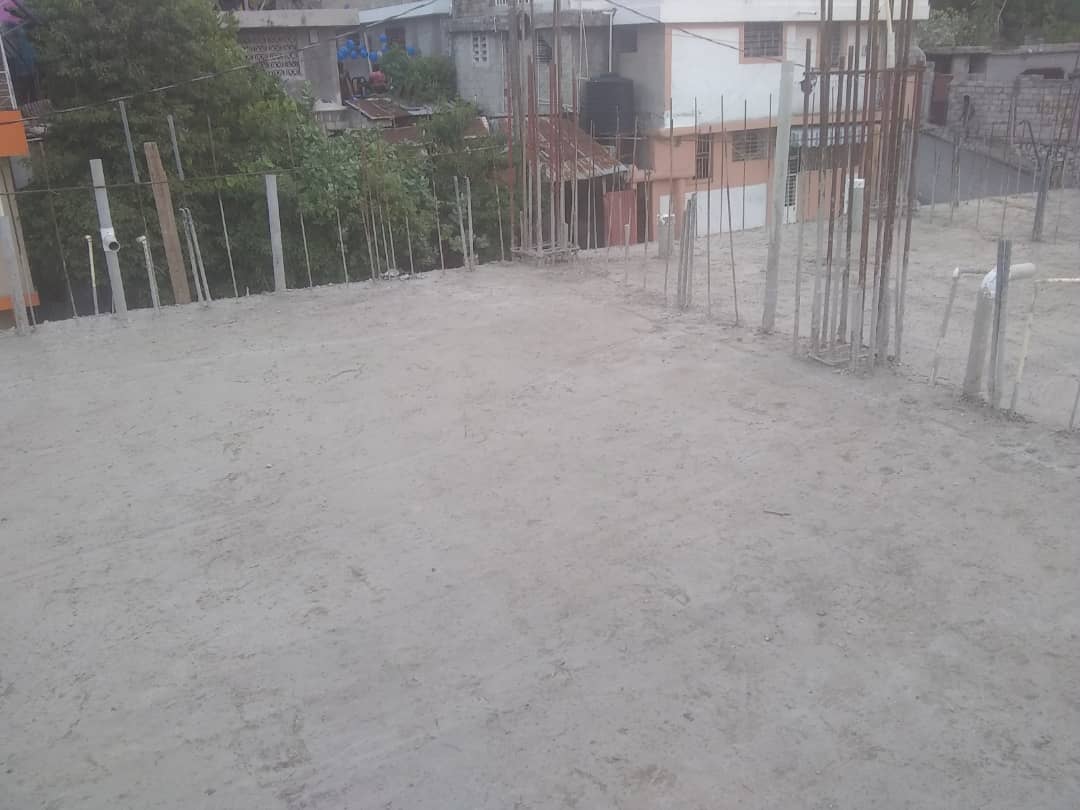

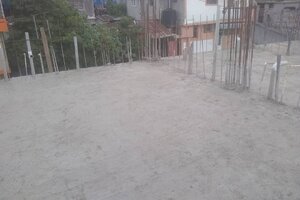

3rd floor finished!

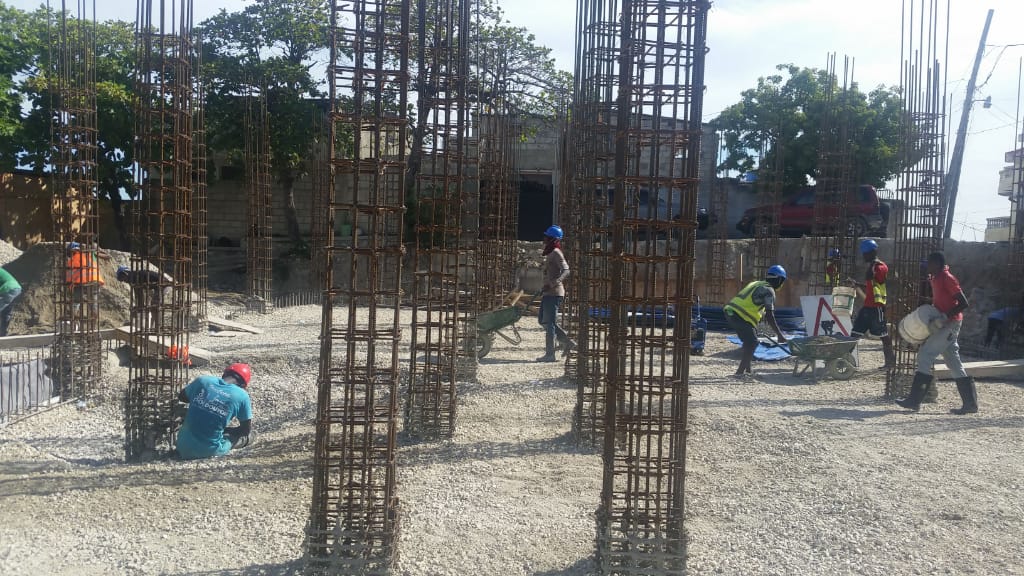

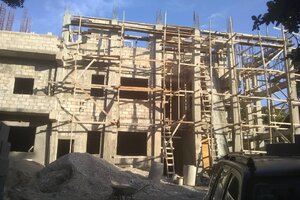

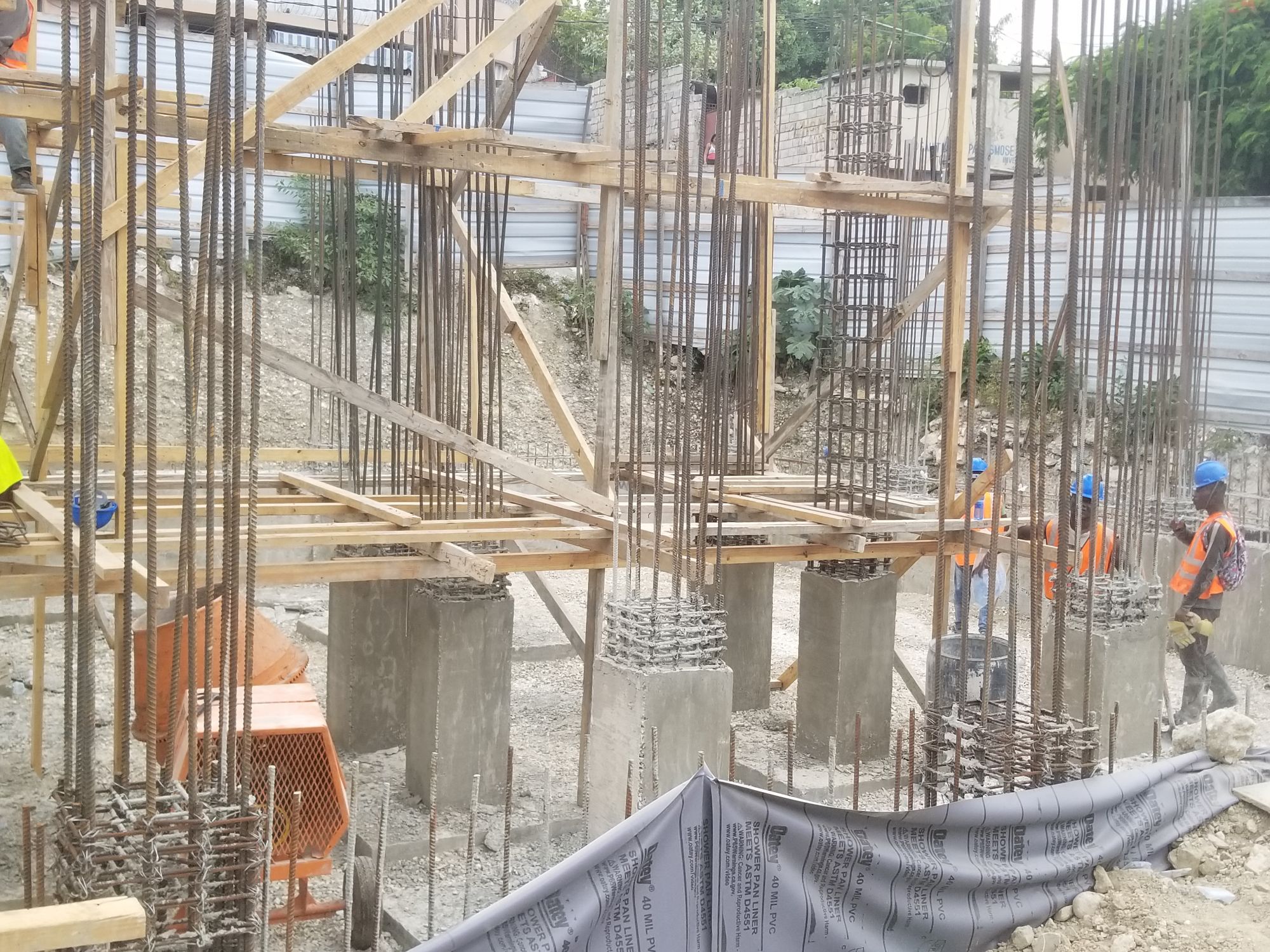

Construction resumed (from pandemic halt) late August. These pictures are from September 10.

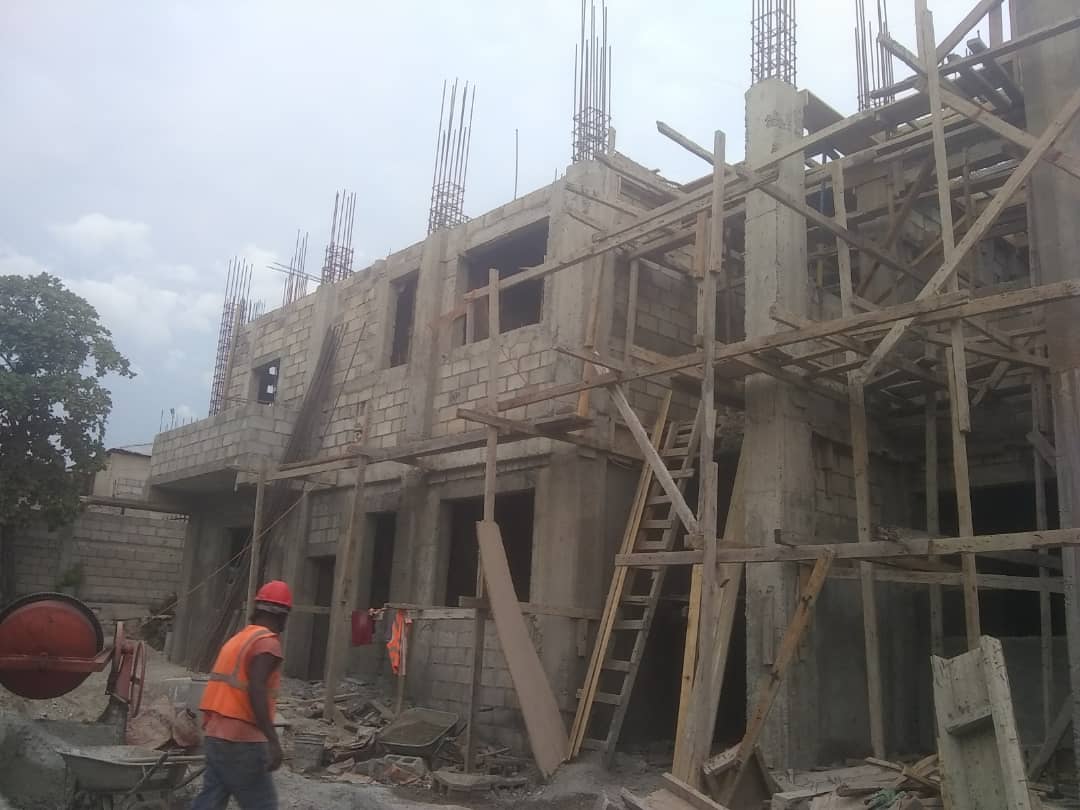

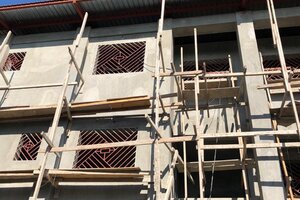

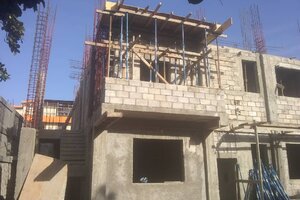

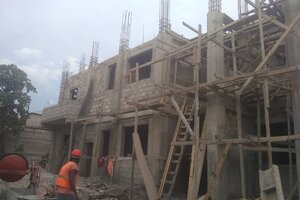

These are from the main face of the building (facing the northwest)

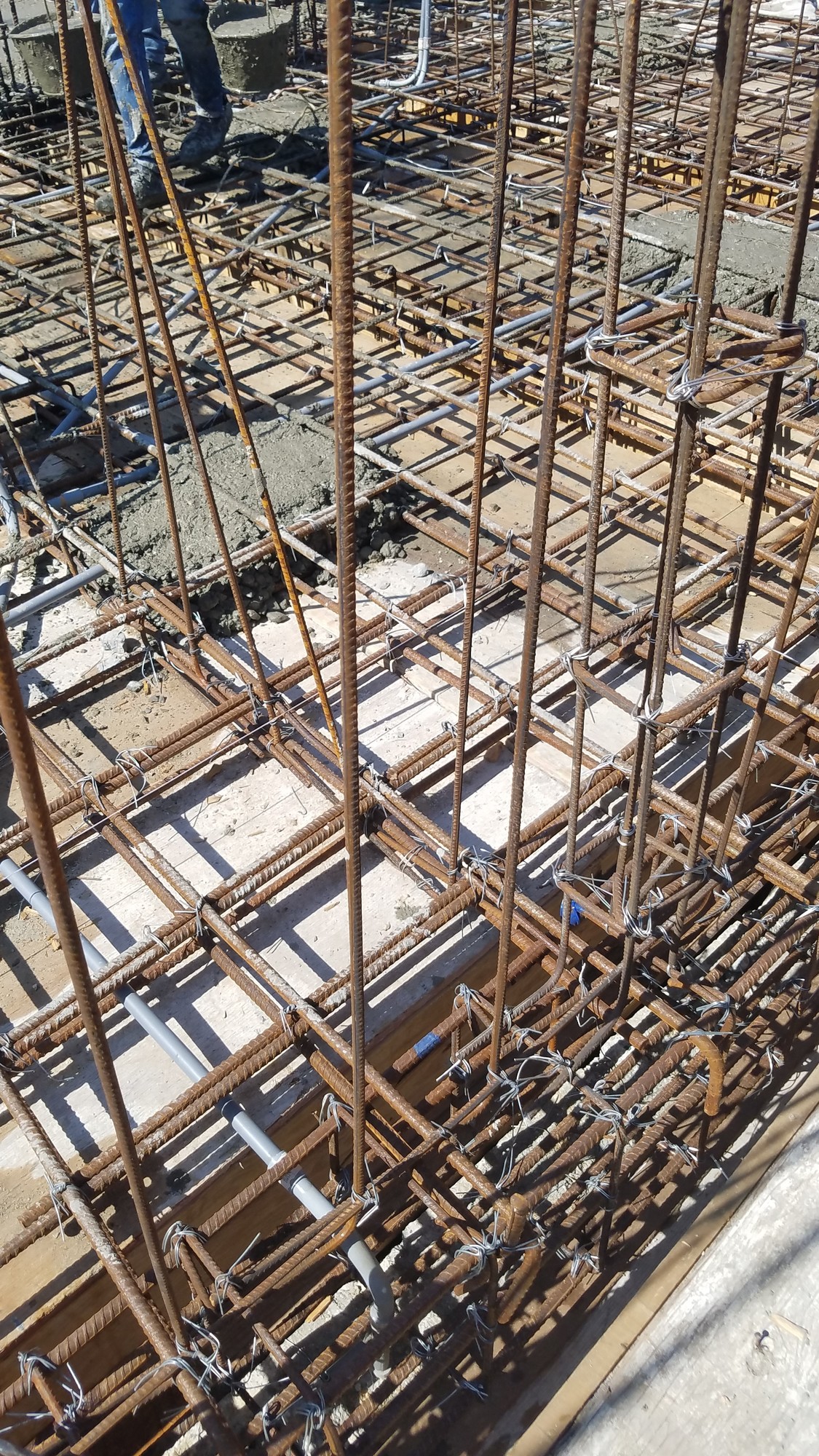

These pictures are form the end of February 2020, shortly before work was shut down for the Corona Virus pandemic.

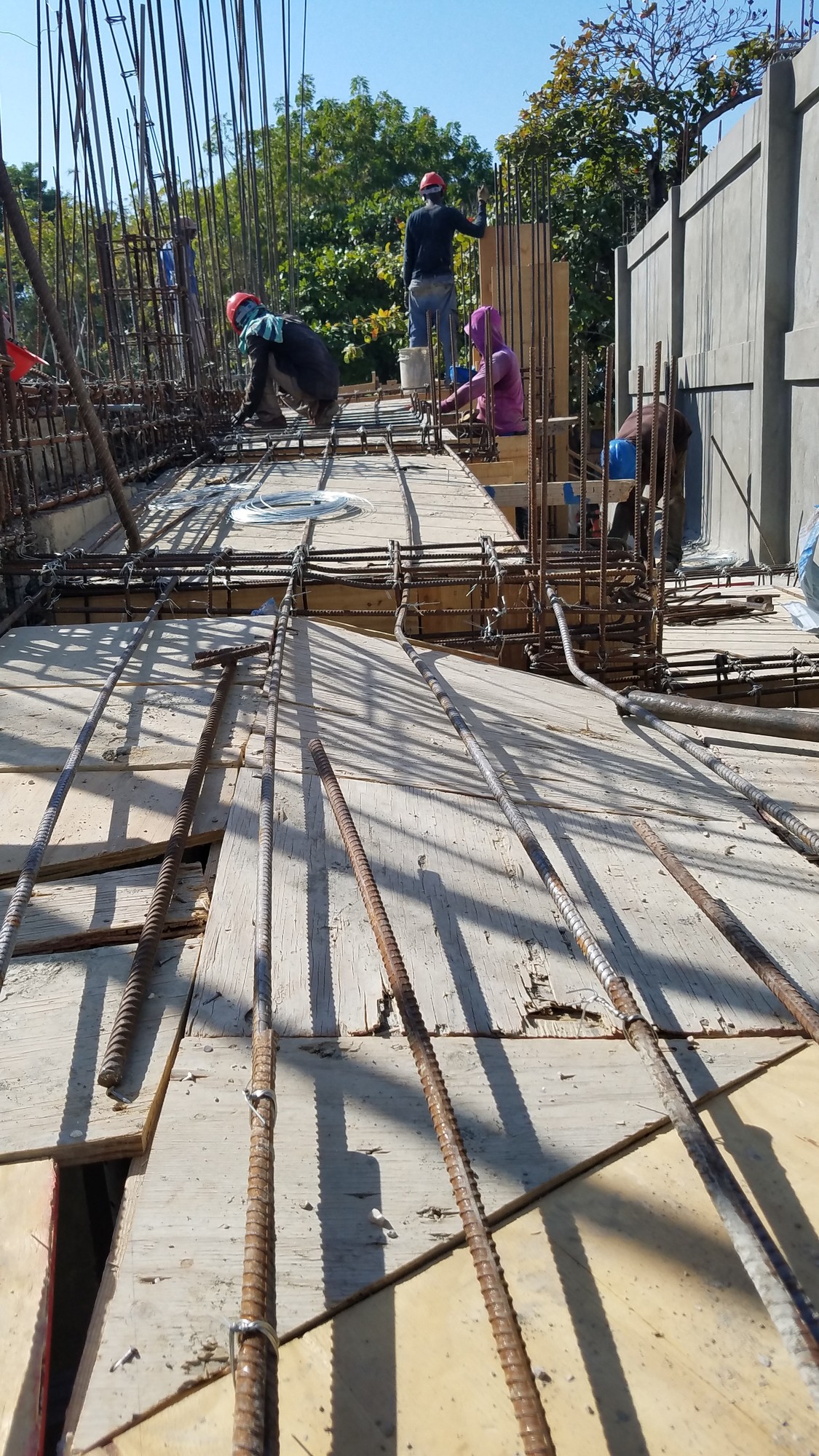

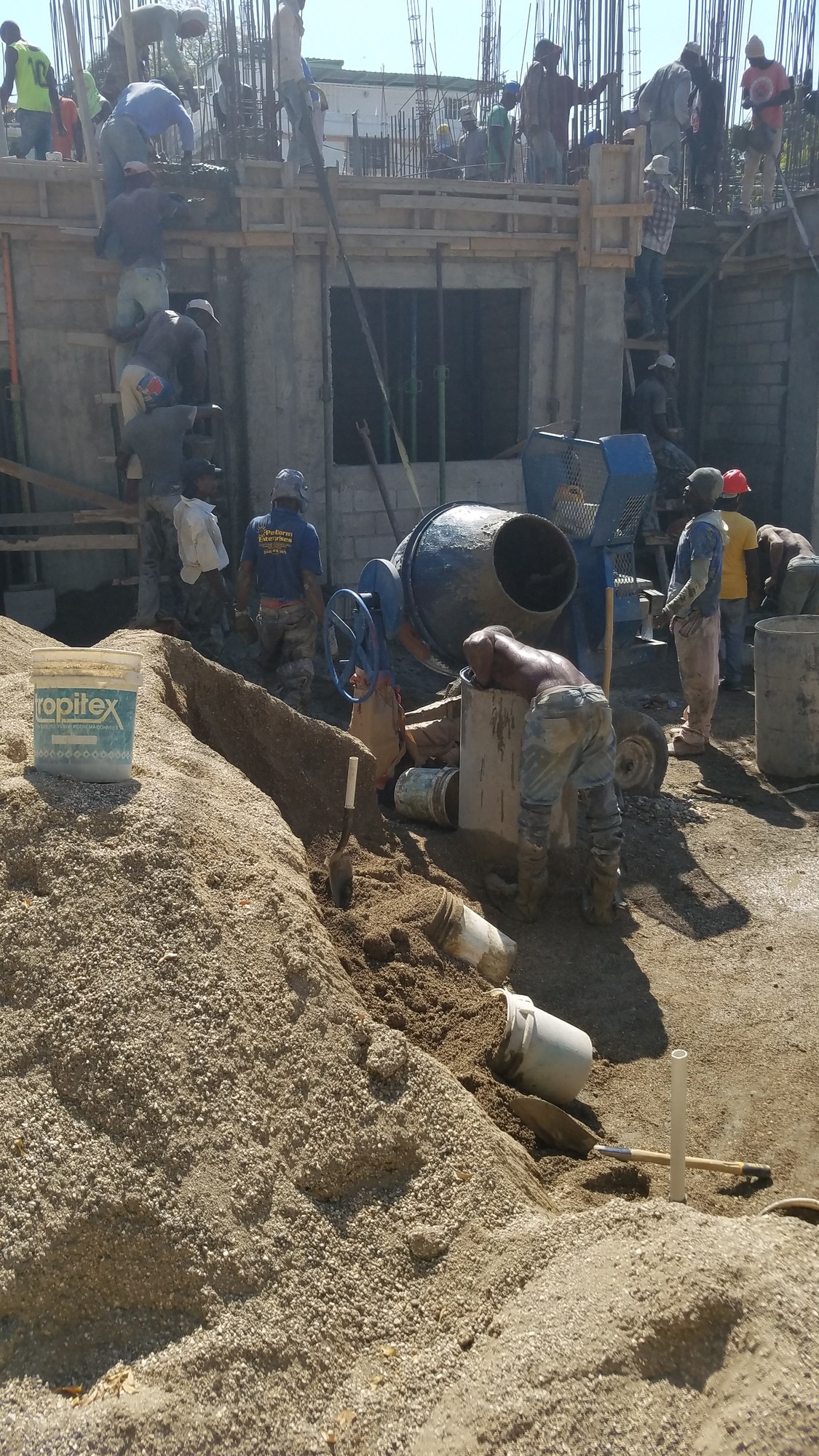

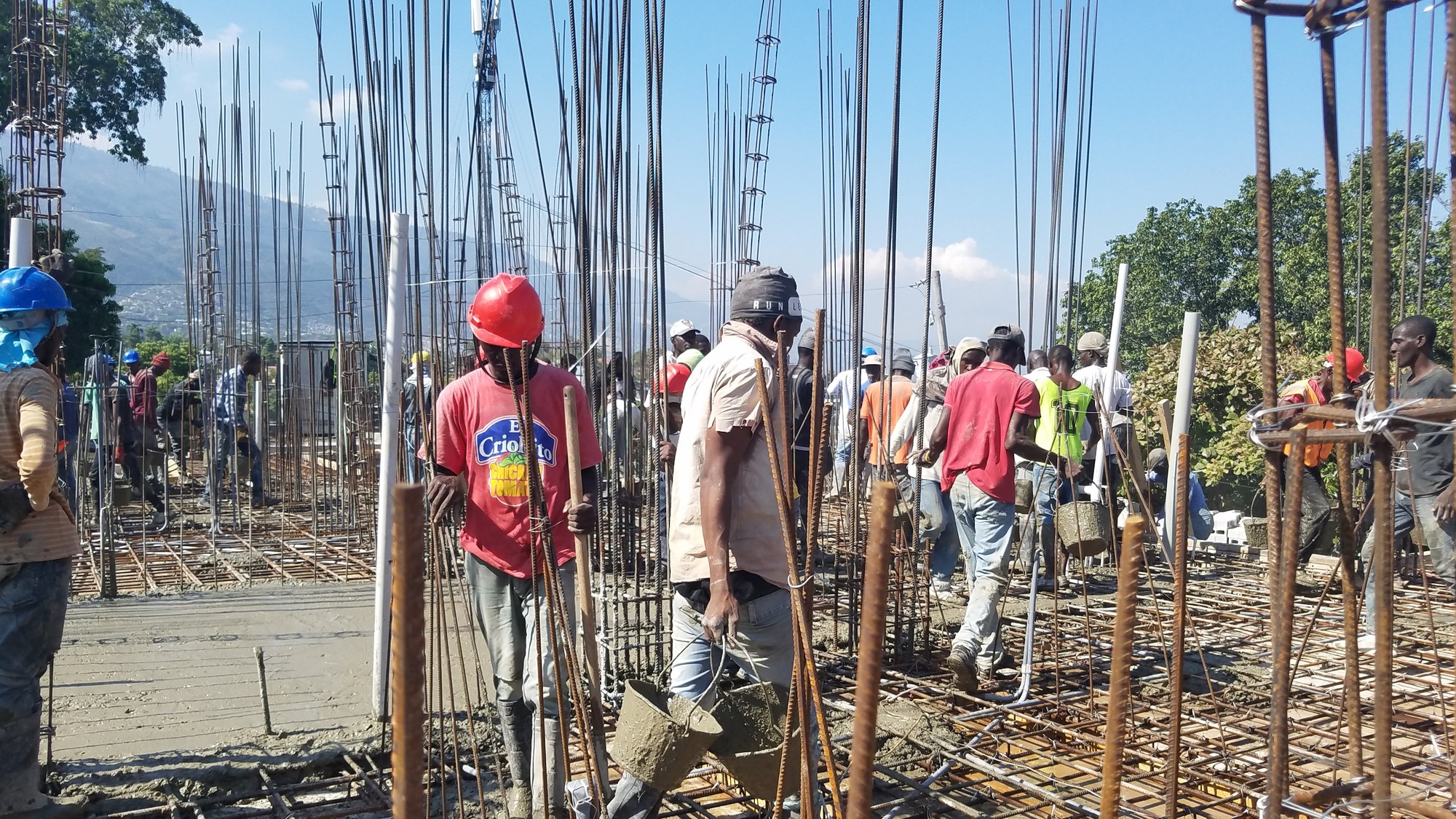

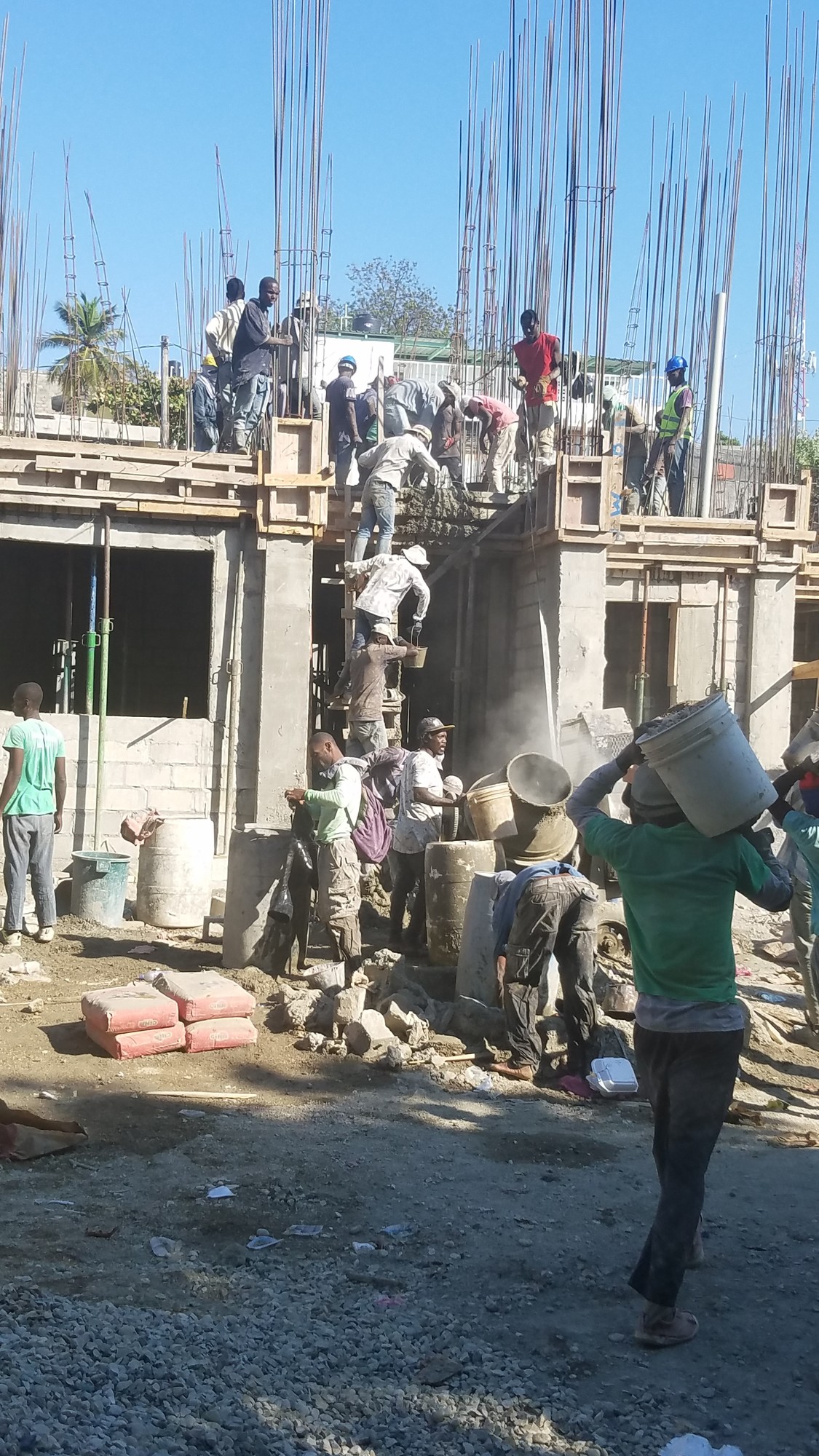

Once progress Resumed in December 2019, progress was swift. These pictures are from the end of February, and show the floor of the second story being poured. A labor intensive process, but it is amazing to see the whirlwind of activity.

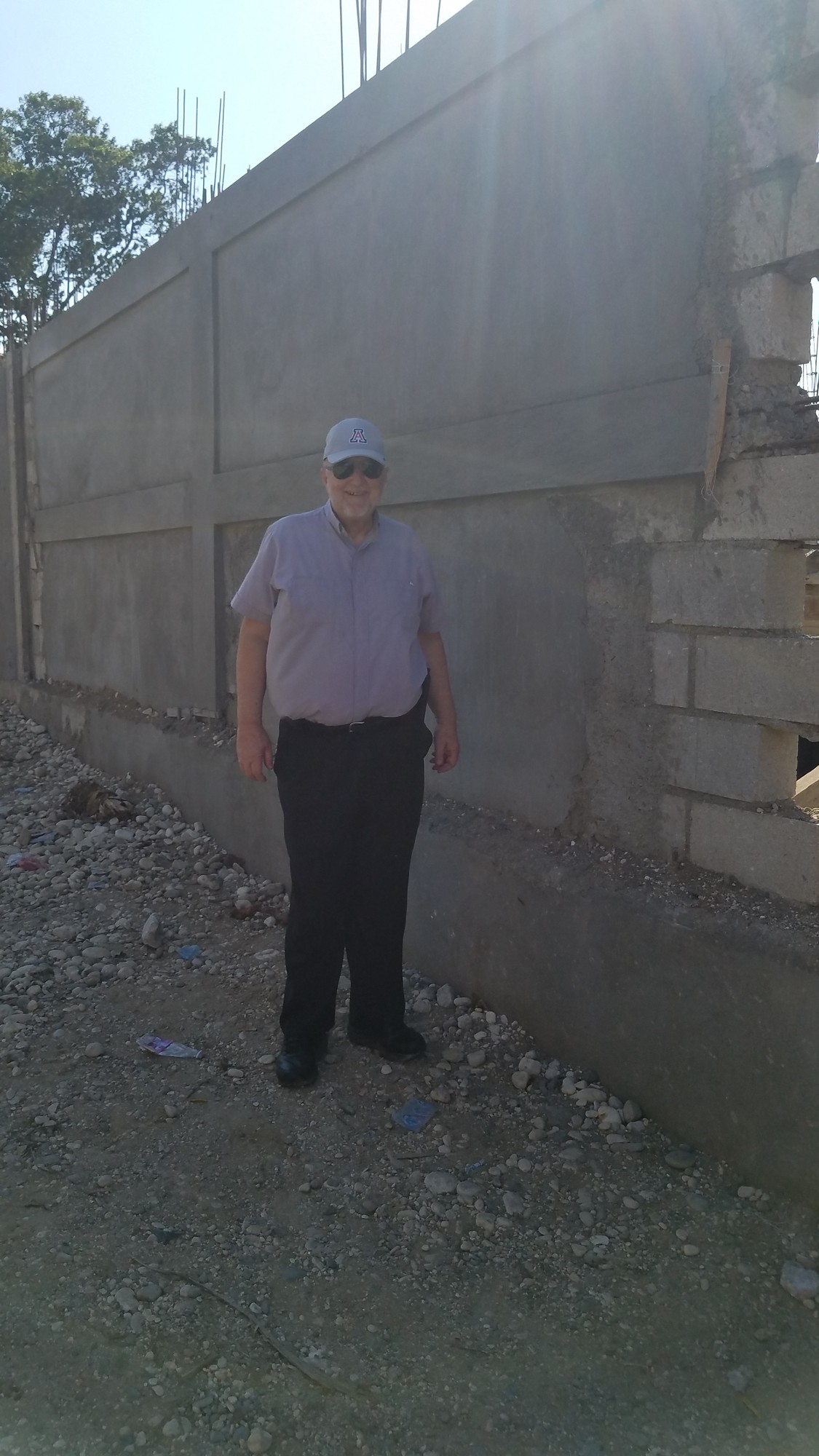

Fr Frank in front of the wall around the Norwich Outreach Center

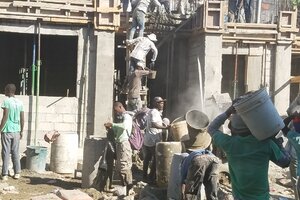

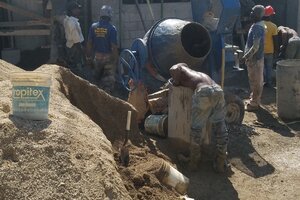

Workers mixing concrete and taking it up to the second floor

Forms for the handicapped ramp allowing access to the offices on the 2nd floor

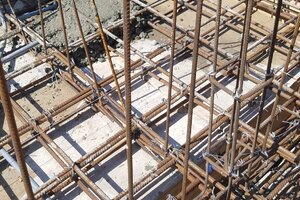

Safety ties at all re-bar intersections, assuring integrity during the pour

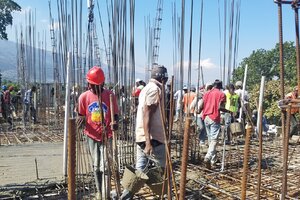

Workers taking concrete across the second floor - bucket by bucket
Workers mixing concrete and taking it up to the second floor

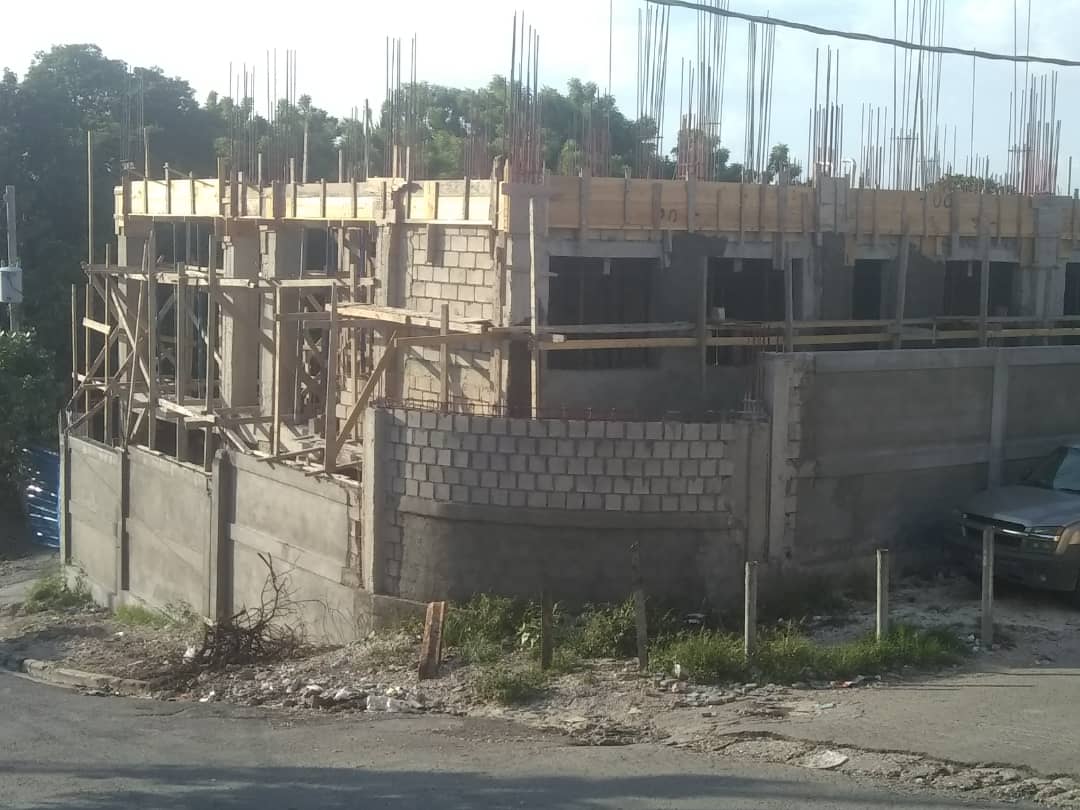

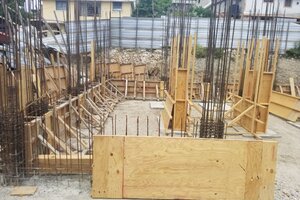

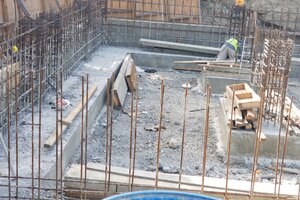

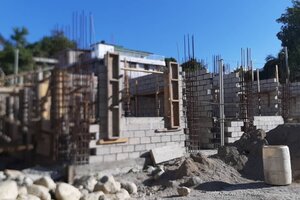

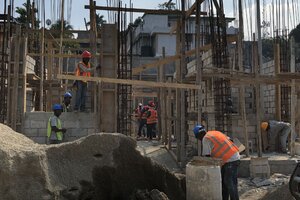

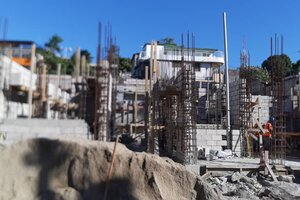

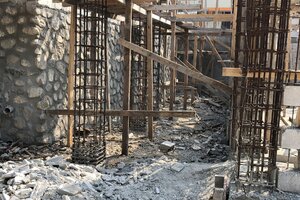

Retaining Wall and First Floor construction

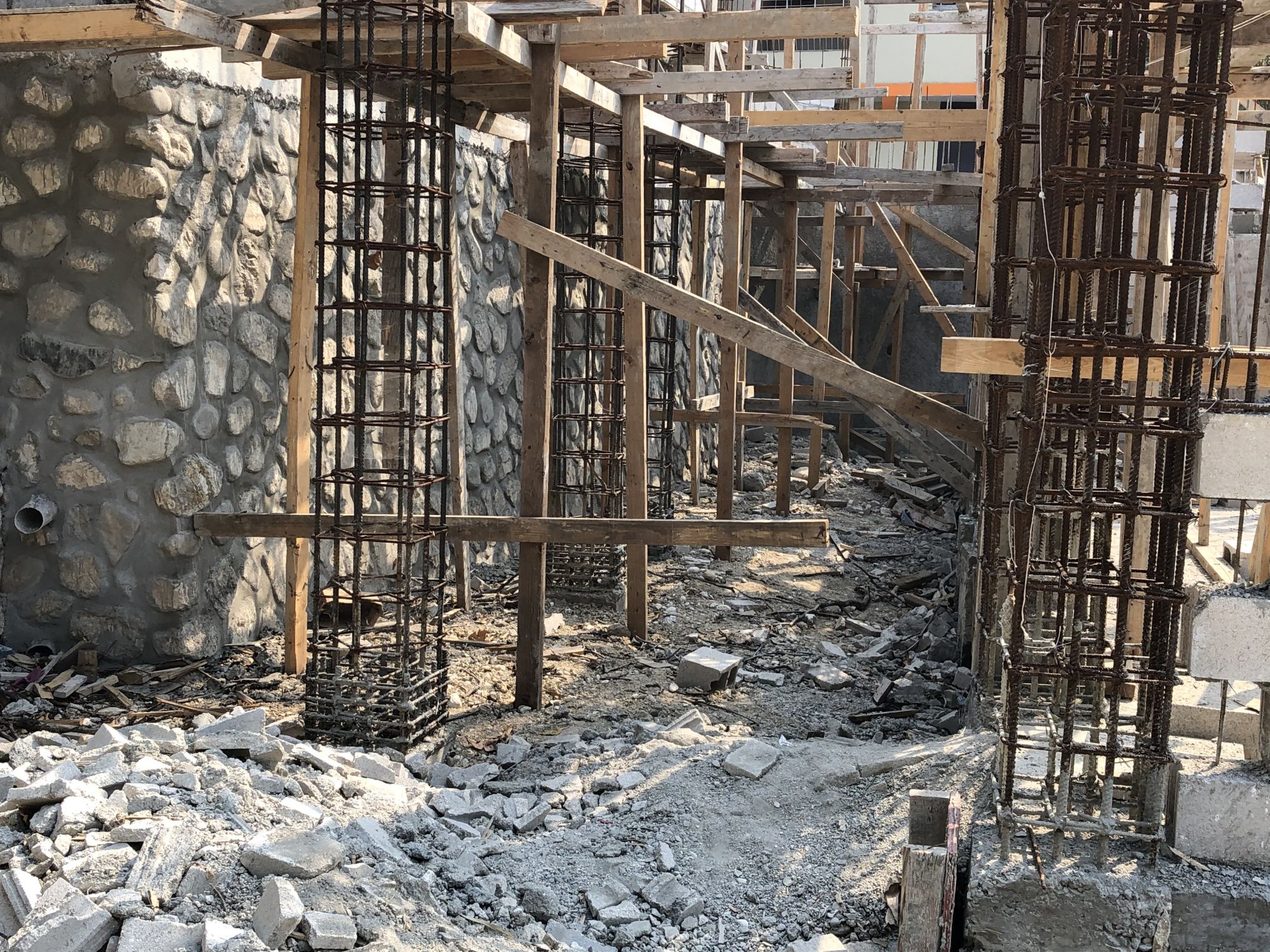

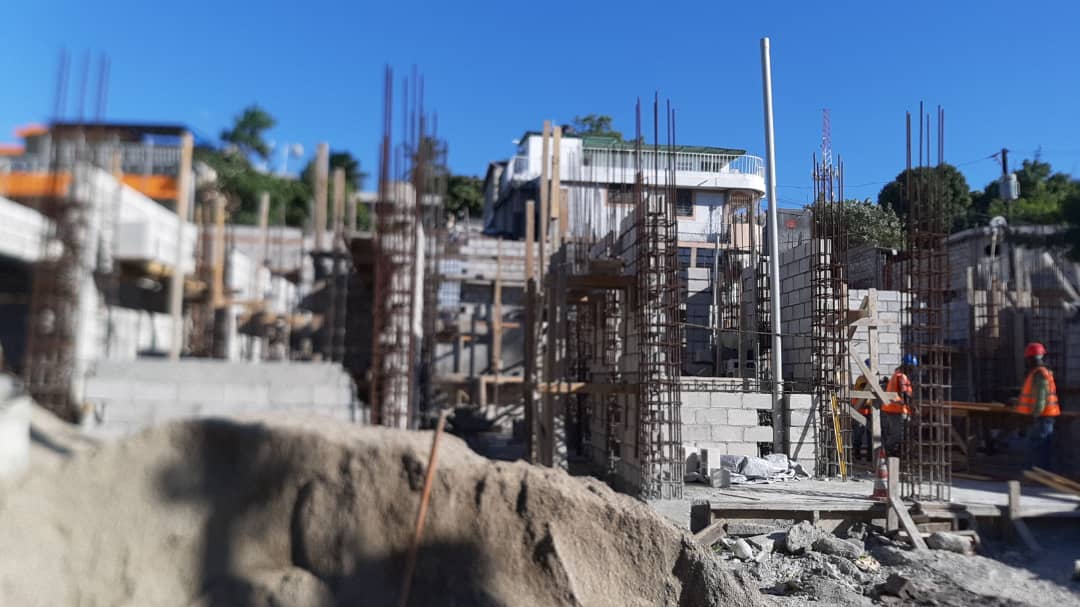

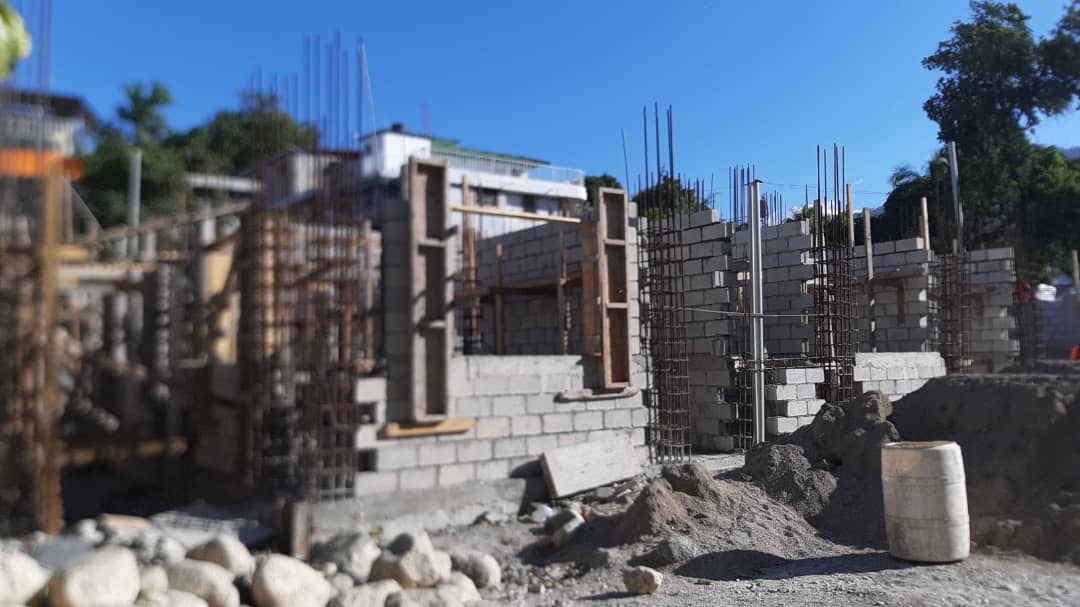

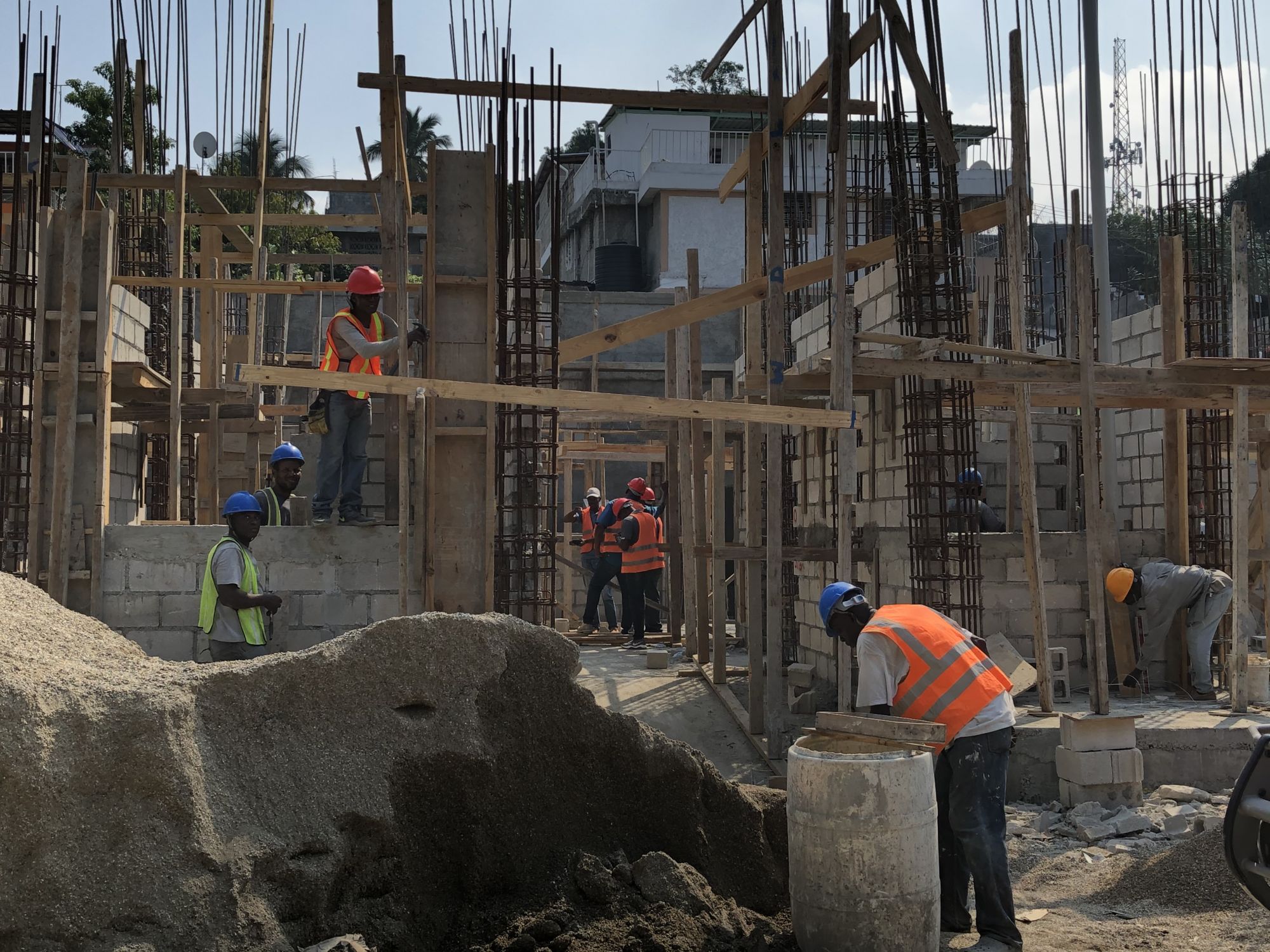

Construction of the building resumed in mid-December, 2019, after a three month pause due to political unrest. There has been great progress since then as shown in these pictures as of 1-13 and 1-27.

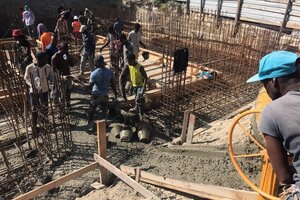

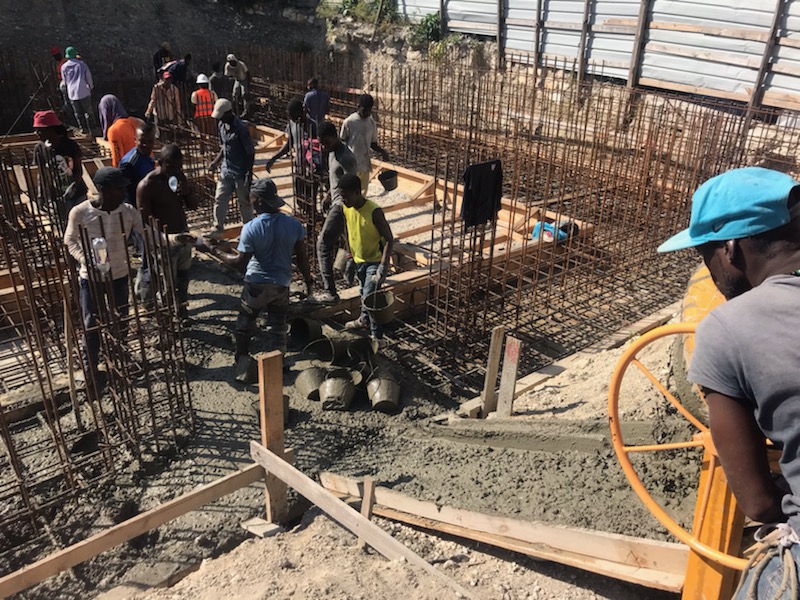

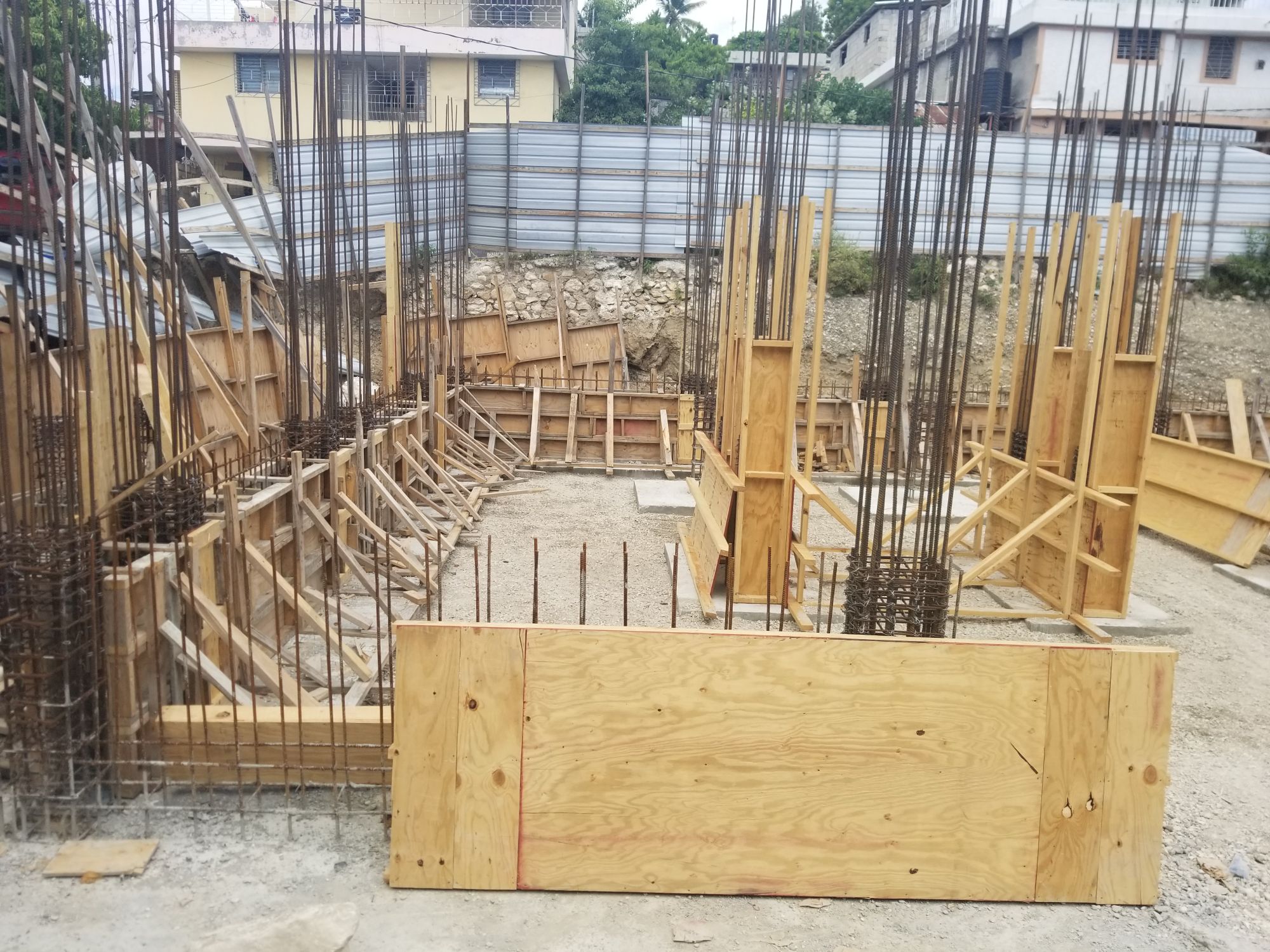

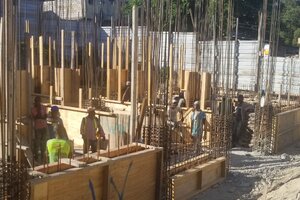

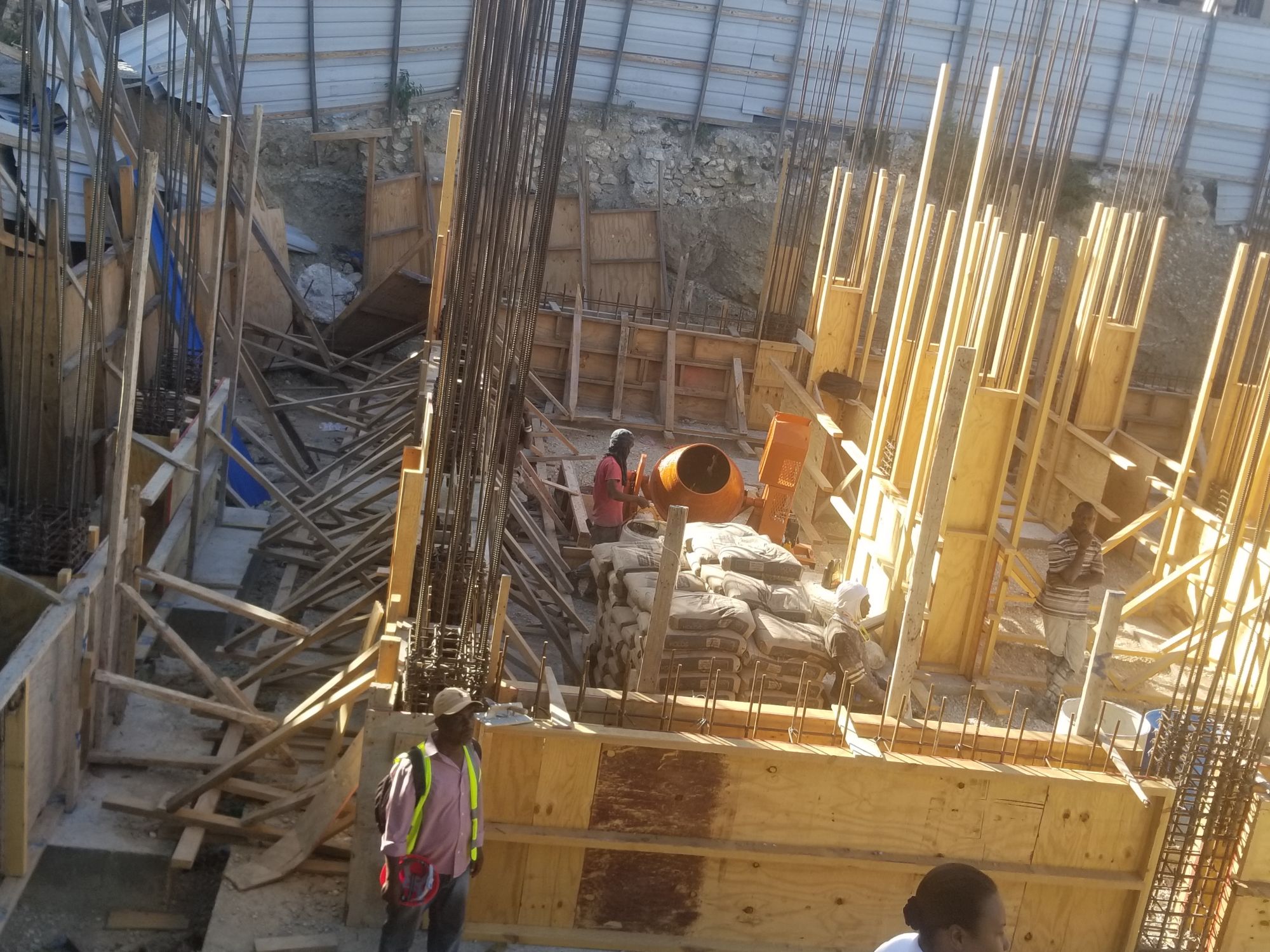

6-25-19 Great news....the concrete pour starts!
Start of Construction Phase

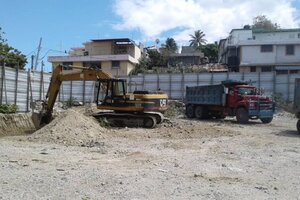

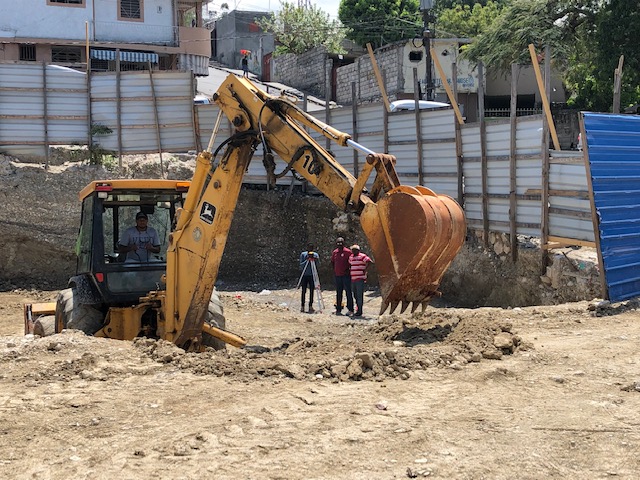

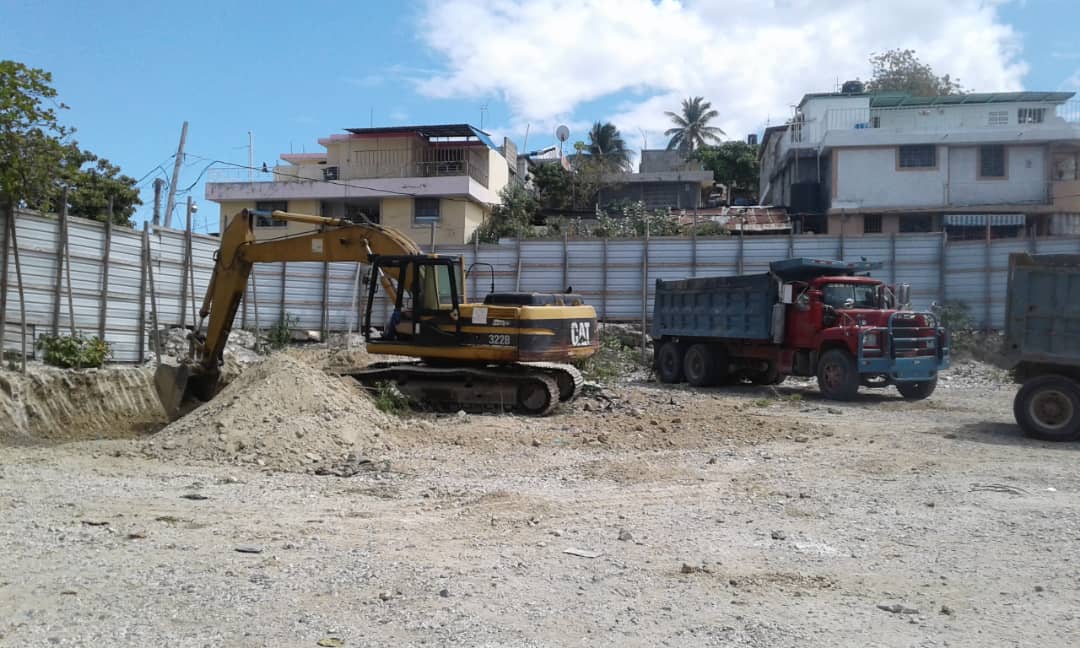

Excavation Starts - March 10, 2019

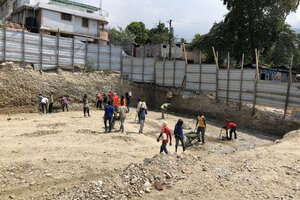

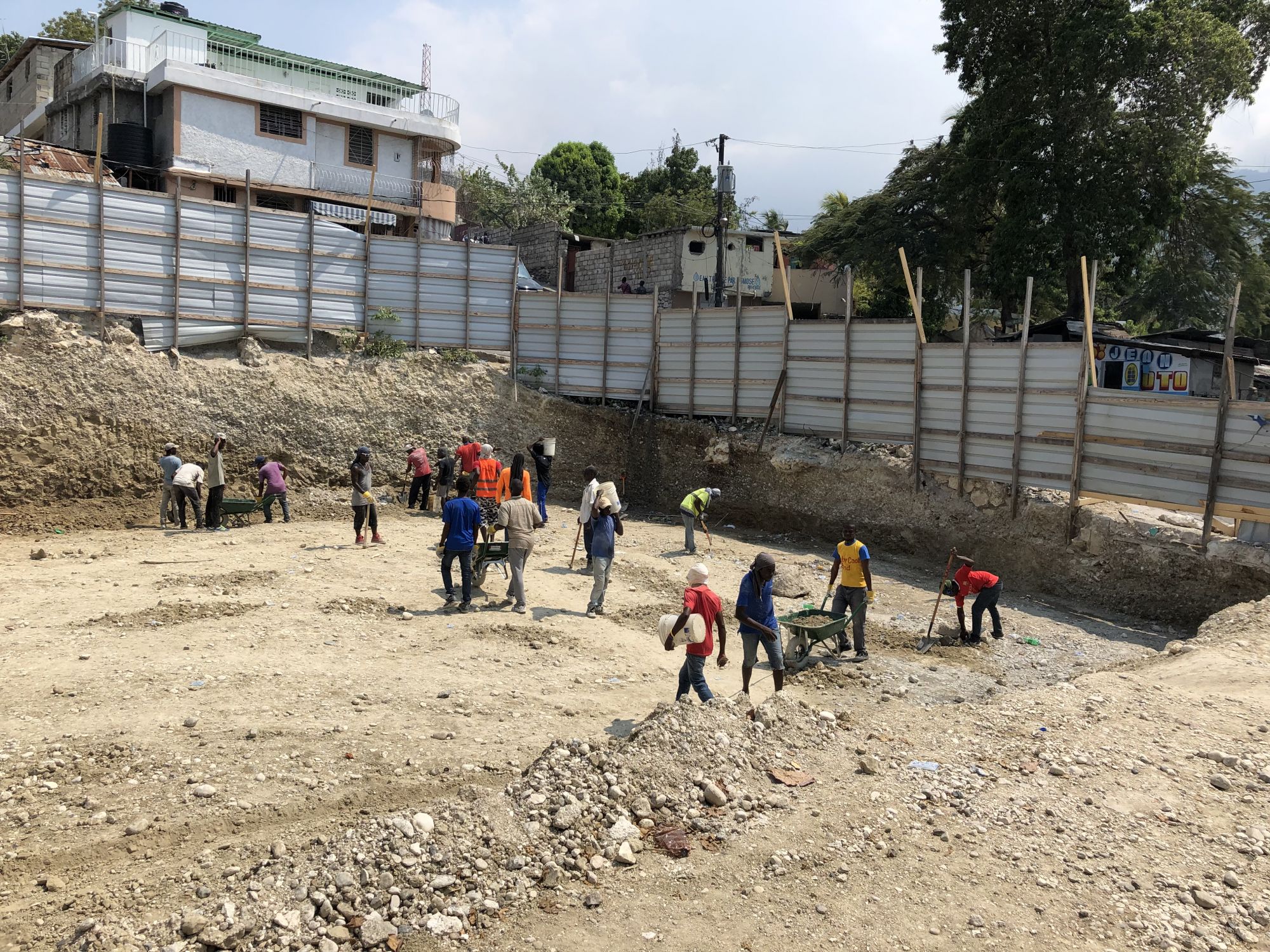

Manual fine-tuning of excavated site

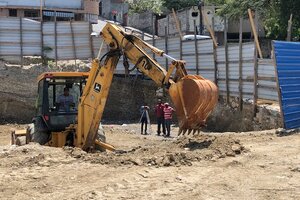

Outreach Center provides jobs to neighborhood workers, who fine-tune the site

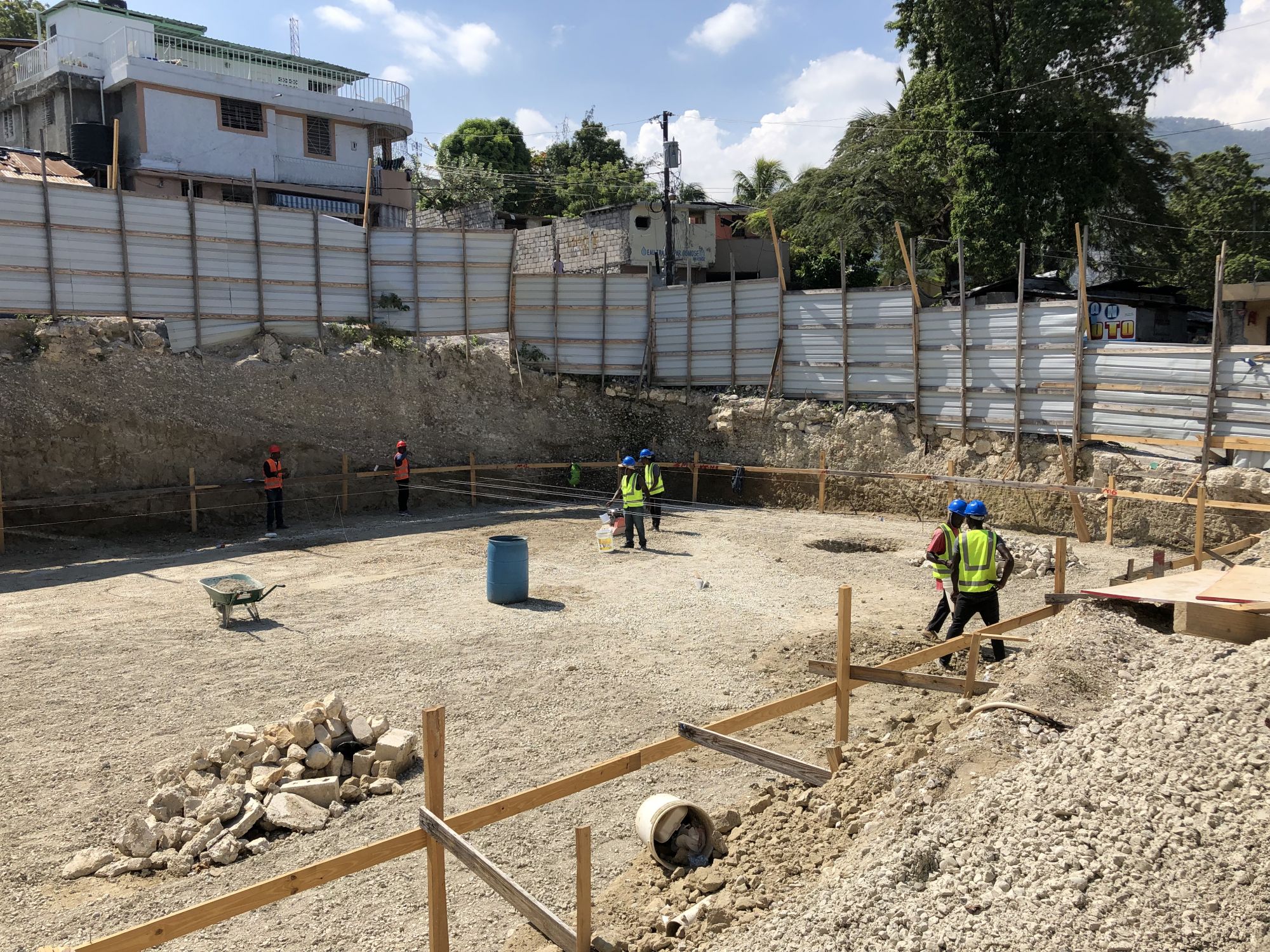

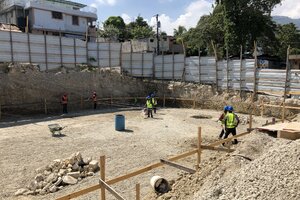

4-9-19 building footprint, hole for support pier

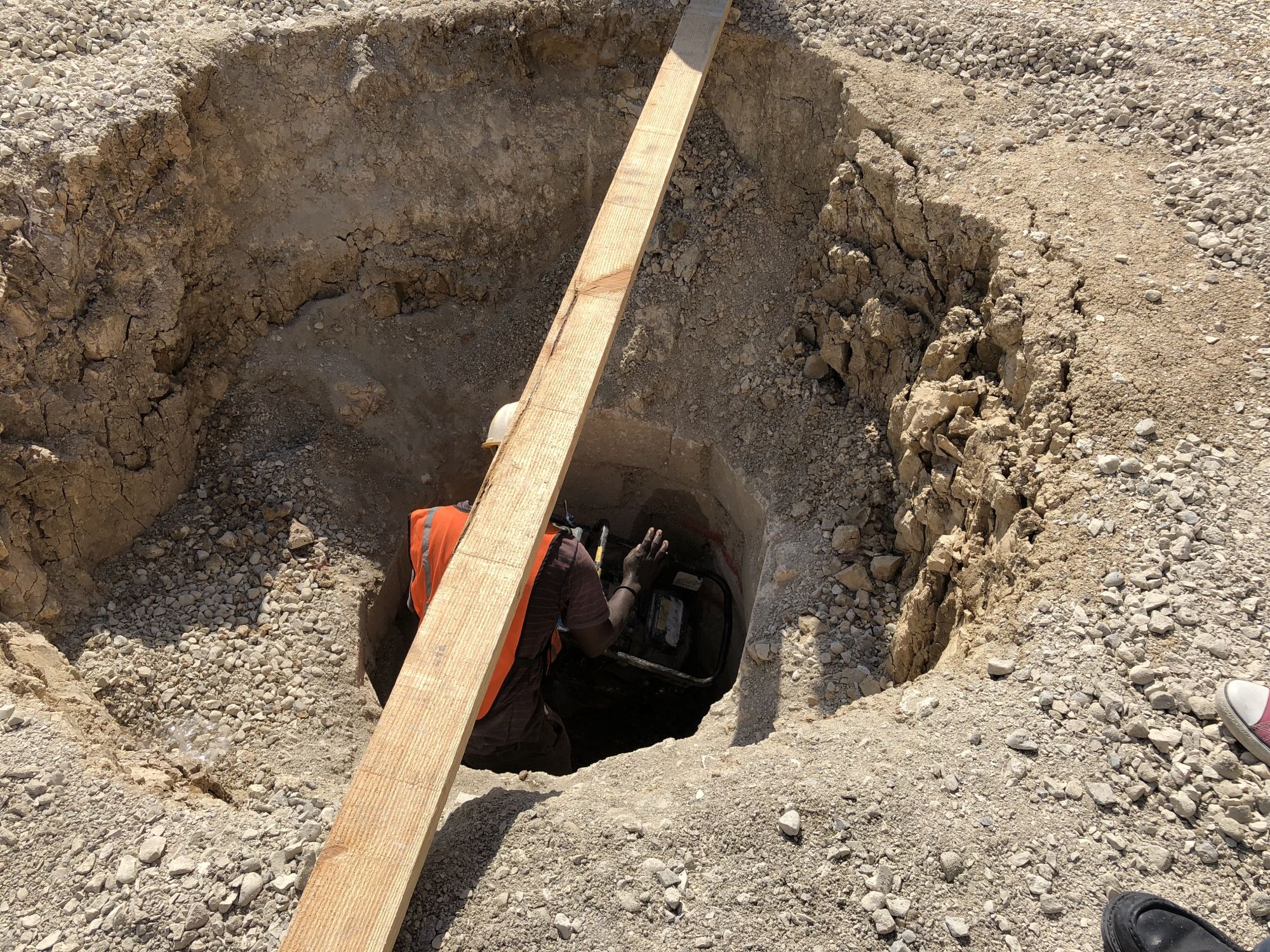

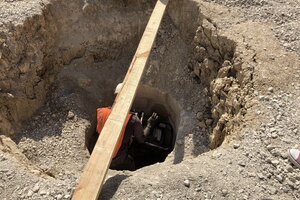

Deep holes dug, filled with special mix, and compacted as filled to provide strong support for building - see man in hole for scale

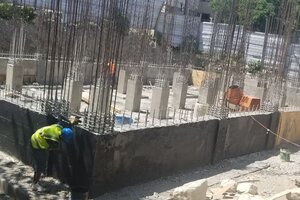

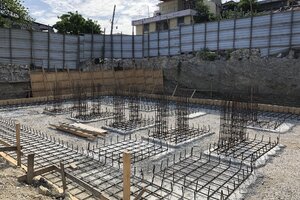

5-13-19 Holes dug, filled, base concrete poured, and rebar jungle starting to grow!

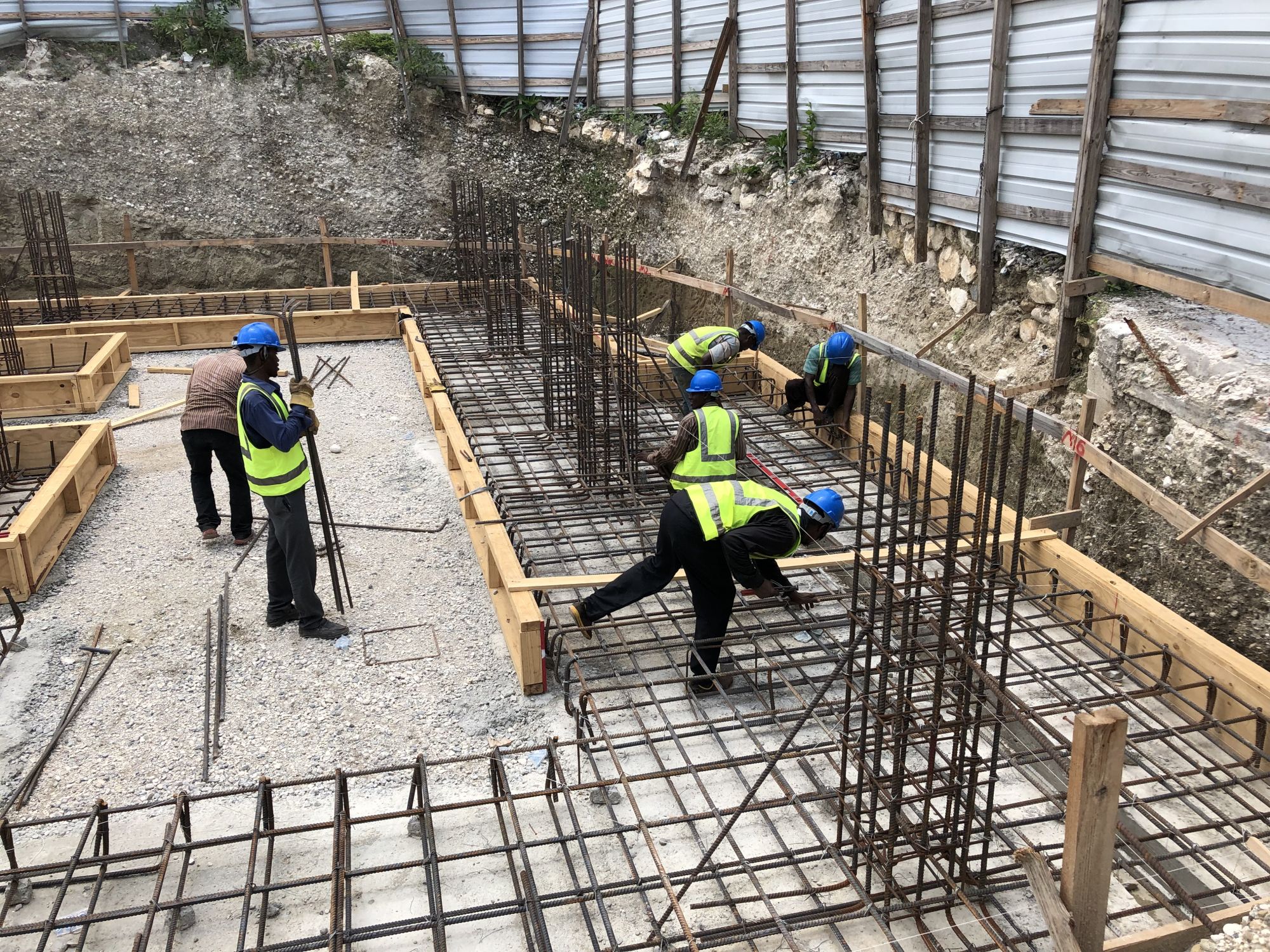

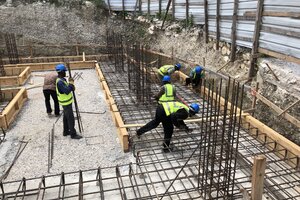

5-21-19 Rebar for side wall going in

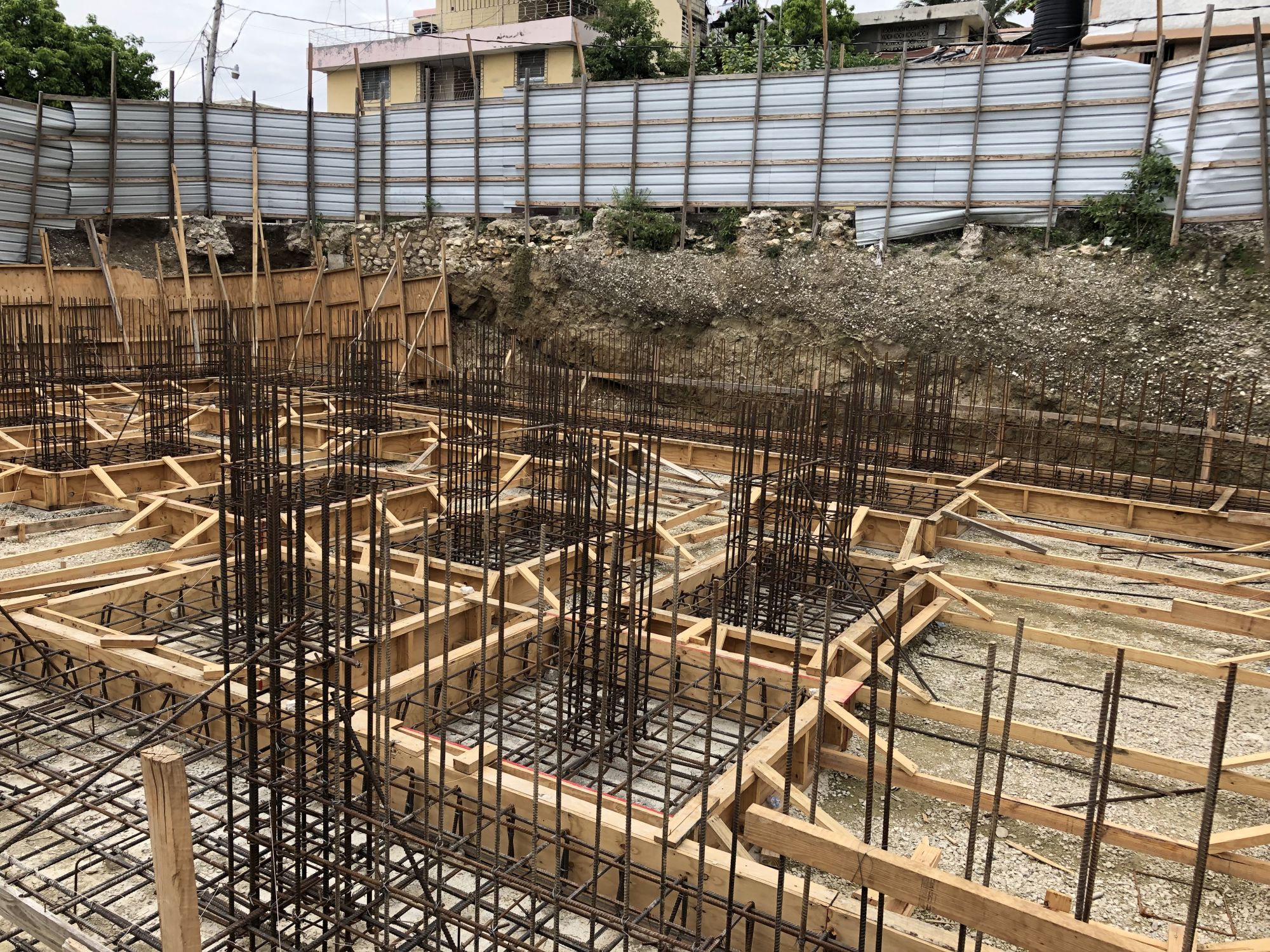

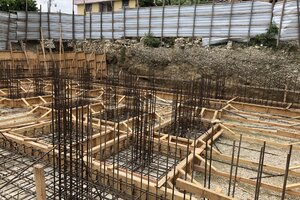

5-28-19 left side -more rebar

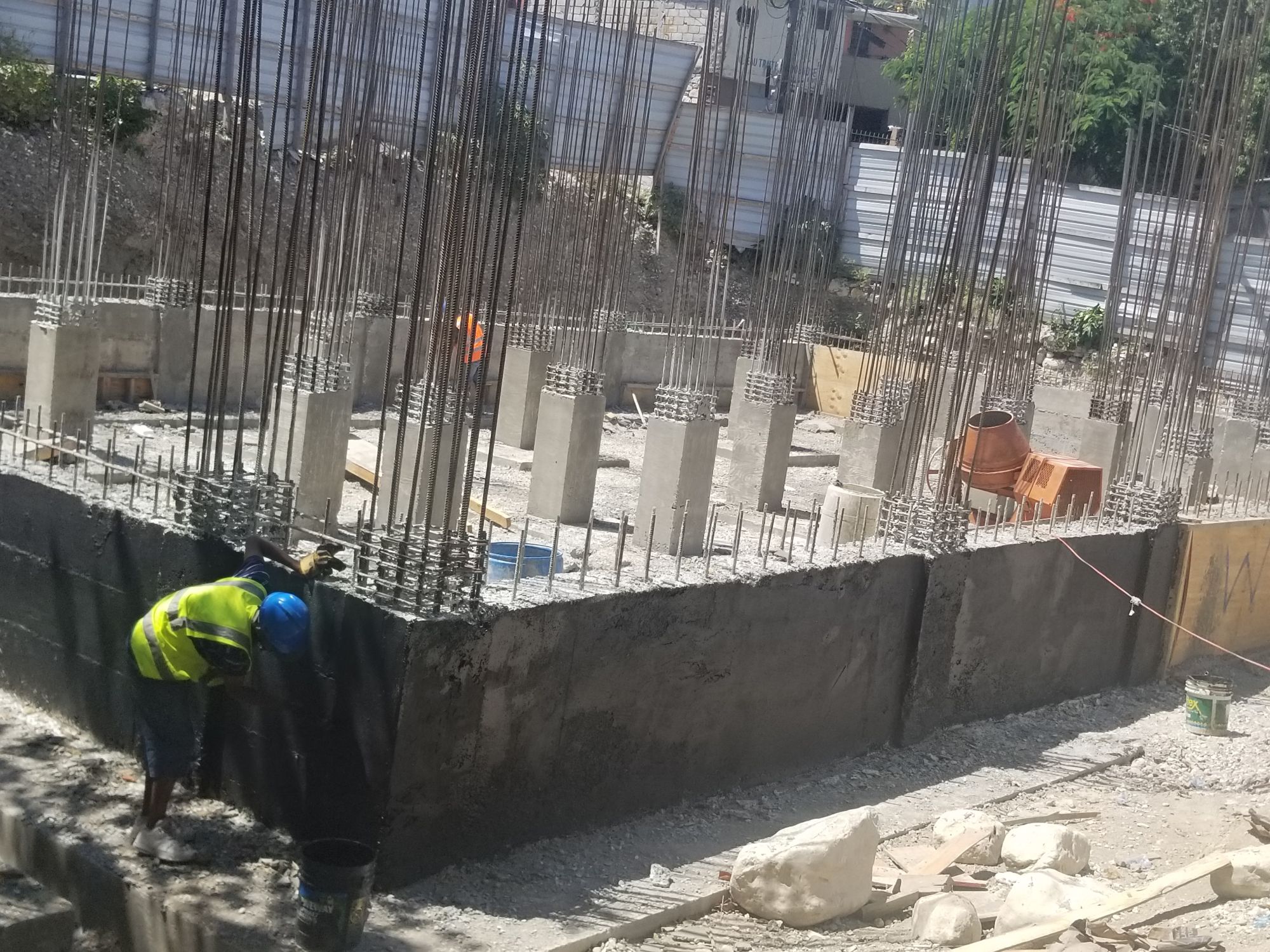

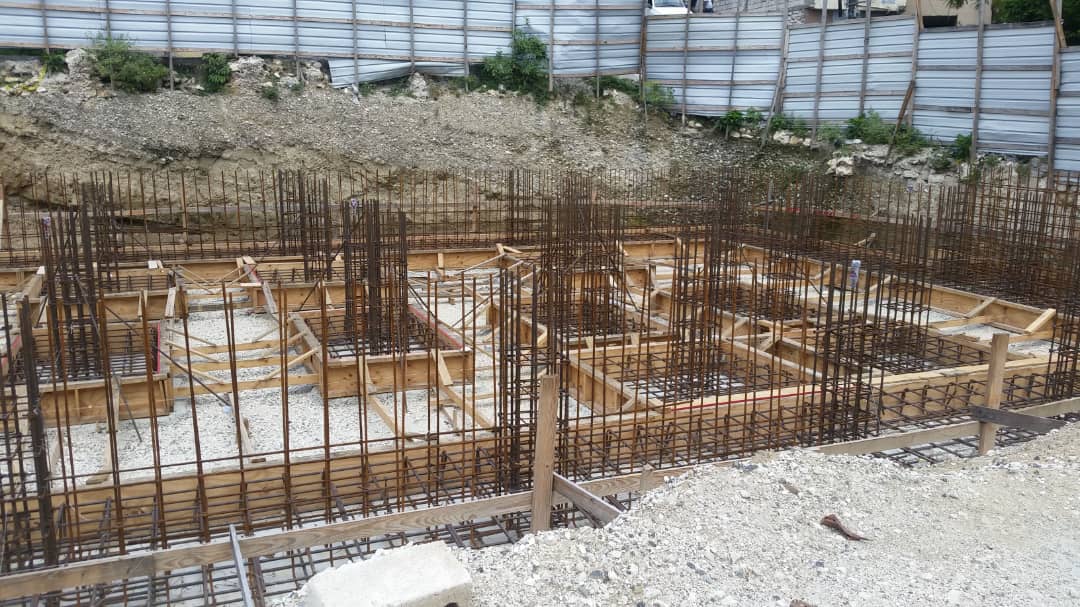

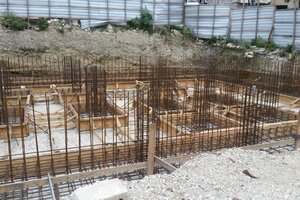

6-7-19 getting close - strong foundation is key!

Demolition Phase
Demolition started on November 30, 2017. It was completed three weeks later.
